Piraeus Project progress

November 2013

The first 44 out of the overall 6,346 meters of the Project’s tunnel have already been bored and 43 out of the 4,243 rings have already been installed; The general excavation of KORYDALLOS Station is at an advanced stage, since the subject Station is at the 4th excavation level; The…
Μάθε Περισσότερα

October 2013

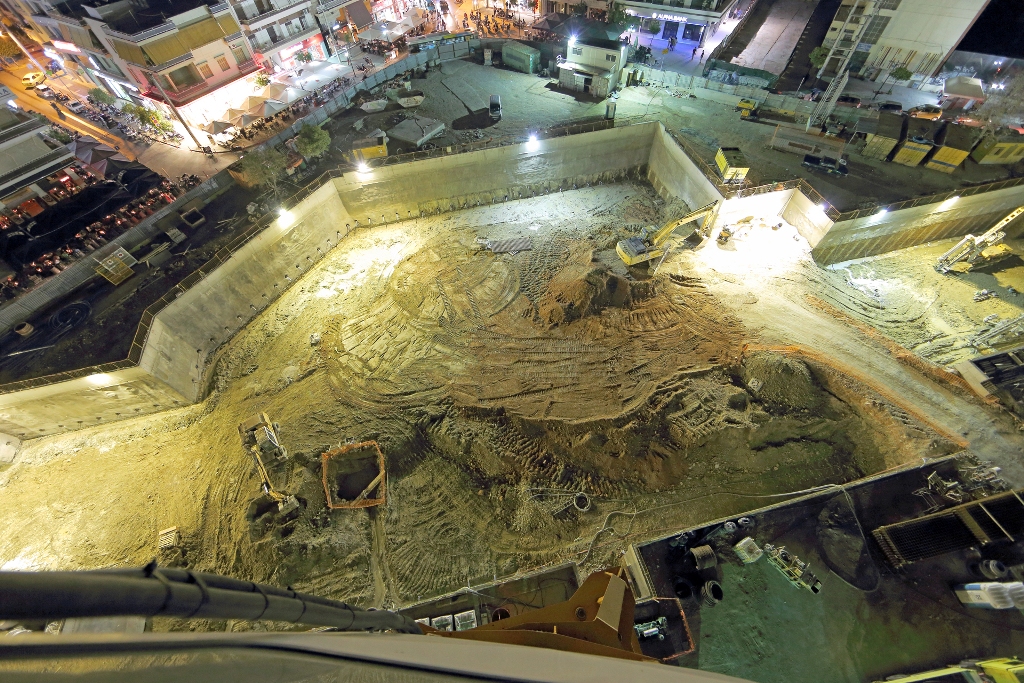

The works for the construction of the foundation slab at the TBM start-up shaft have been completed; The works for the construction of the pile cap beam of AGHIA VARVARA Station are in progress; The works for the excavation and the temporary retaining of KORYDALLOS Station are in progress; The…
Μάθε Περισσότερα

September 2013

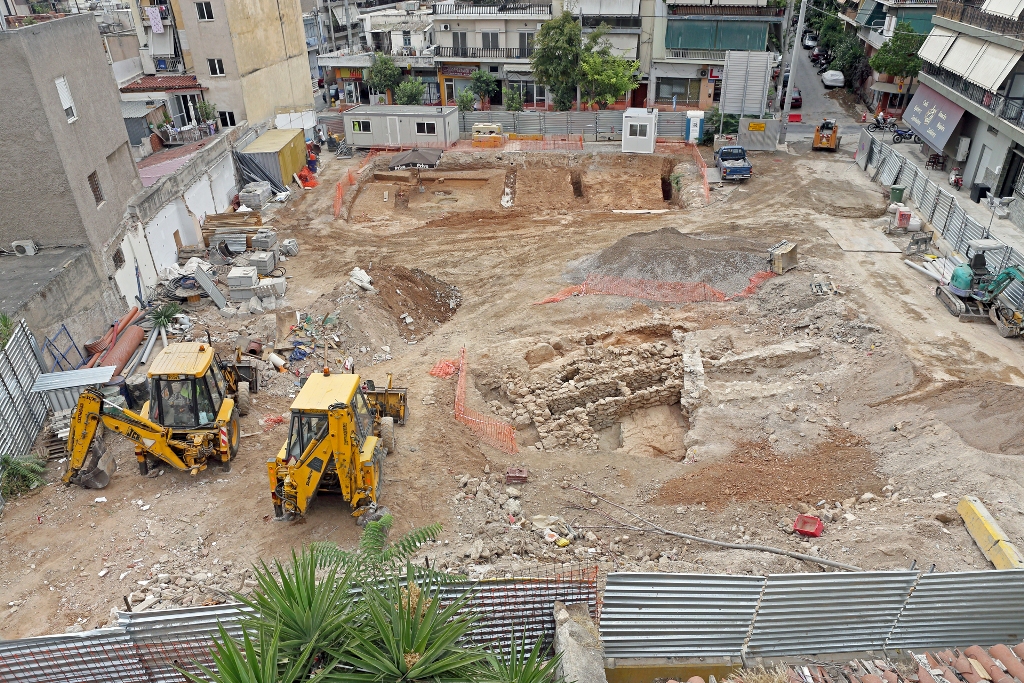

The excavation and retaining works of the NATM tunnel towards Piraeus at the TBM Access Shaft, as well as the drainage and waterproofing of the shaft’s bottom have been completed; The excavation works in AGHIA VARVARA Station are in progress, while the construction works for temporary retaining piles have been…
Μάθε Περισσότερα

August 2013

The assembly of the Tunnel Boring Machine (TBM) in the Access Shaft is at the completion stage; The works for the construction of piles and the pile cap beam in KORYDALLOS Station are in progress; The dismantling works at the surface level and the works for the PUO networks diversion…
Μάθε Περισσότερα

June 2013

The works for the construction of the foundation slab (reinforcement and concreting) and the drilling of the forepoles towards Piraeus at the TBM access shaft were completed, while the excavation works for the retaining of the NATM tunnel to AGHIA MARINA Station in the Municipality of Aghia Varvara are in…
Μάθε Περισσότερα

May 2013

The works for the PUO network diversions were completed in AGHIA VARVARA Station, while the worksite installations and the pile construction works for the temporary retaining of the Station are in progress; The investigation trenches for the identification of the foundations of the Piraeus Port Authority S.A. (OLP) pedestrian bridge…
Μάθε Περισσότερα

April 2013

The works for the drilling of forepoles towards Piraeus at TBM start-up Shaft are in progress; The archaeological excavation works at the south and north-eastern section of the main station, as well as the traffic regulations for the diversion of OTE network at Grevenon Street in NIKEA Station have been…
Μάθε Περισσότερα

March 2013

The works for the construction of temporary retaining piles and the pile cap beam at the TBM start-up shaft have been completed; The works for the dismantling of shop sheds, as well as for the construction of new sidewalks at the eastern and southern part of Eleftherias square at KORYDALLOS…
Μάθε Περισσότερα

February 2013

The first phase of the traffic arrangement has been completed and is in full swing, while the works for the construction of new sidewalks at the perimeter of Eleftherias Square in KORYDALLOS Station area, as well as the diversions of the PUO networks are in progress; The relocation of kiosks…
