Web Portal - Elliniko Metro A.E.
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa

Piraeus Project progress

September 2014

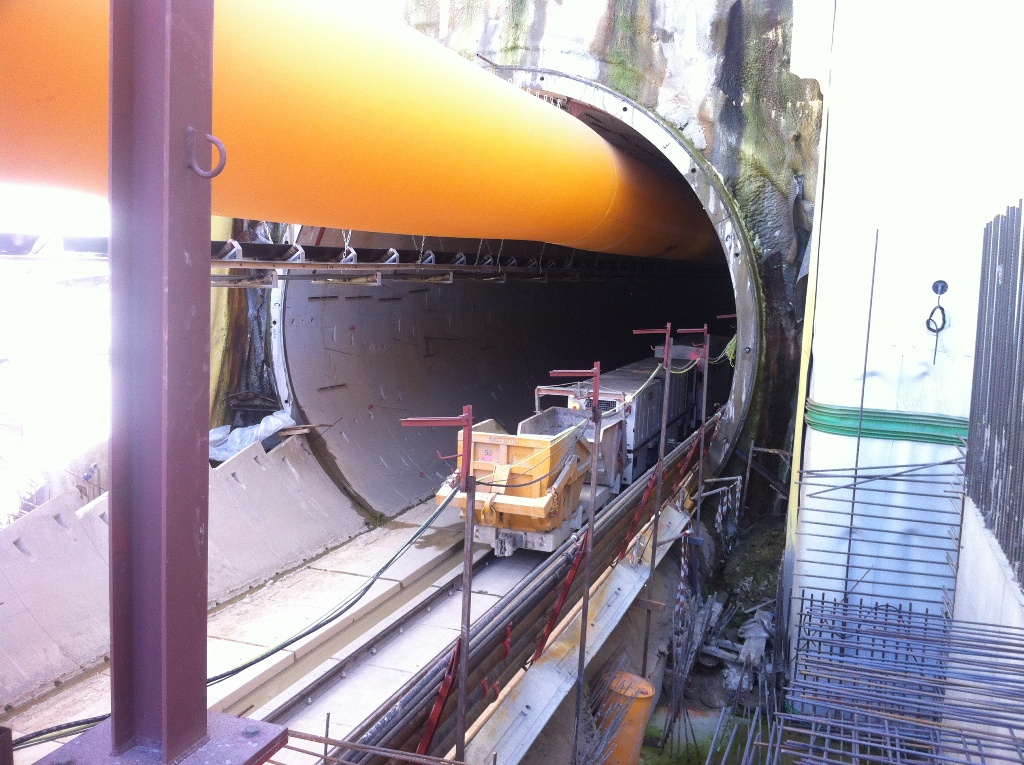

AGHIA VARVARA Station: The works for the construction of supporting columns up to the platform level were completed, while the works for the construction of parapet walls and the platform floor are in progress; NIKEA Station: The works for the temporary drainage of the final excavation floor of the main…
Μάθε Περισσότερα

August 2014

NIKEA Station: The works for the construction of a foundation earthing system, soil improvement works and works for the acceptance of the main Station foundation invert have been completed. Excavation works and works for the removal of the muck (removal of the excavated material from the Station NATM tunnel access),…
Μάθε Περισσότερα

July 2014

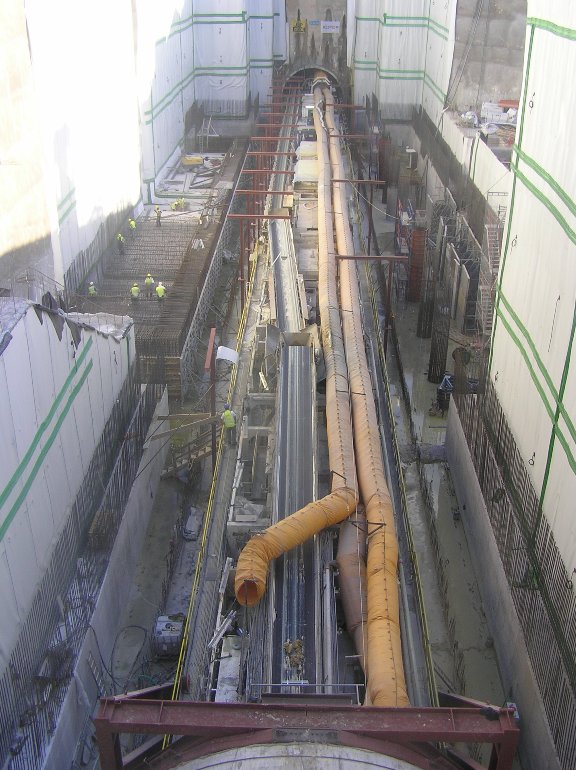

AGHIA VARVARA Station: The works for the construction of the platform columns and floor slab are currently in progress; KOLYDALLOS Station: Completion of the works related to the drilling, embedding and tensioning of the pres-stressed anchors, as well as of the Station’s raft concreting works; NIKEA Station: In progress are…
Μάθε Περισσότερα

June 2014

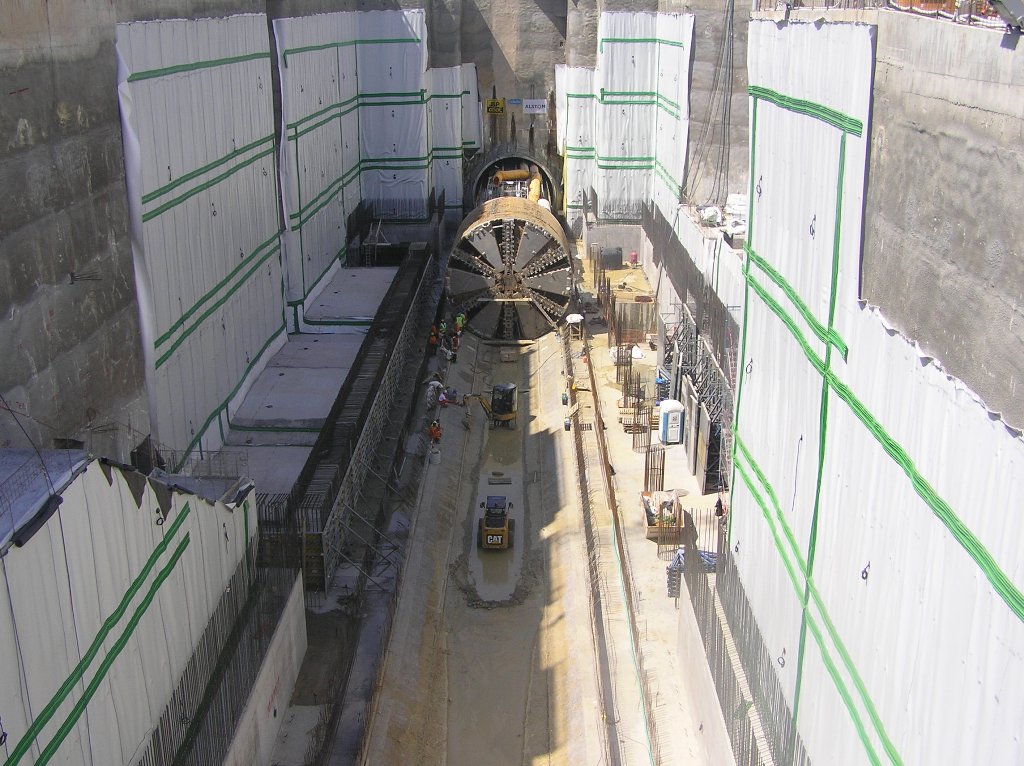

NIKEA Station: The excavation and muck disposal, as well as the construction of the temporary retaining (shotcrete, prestressed anchors, metal struts) at levels 5 and 6 of the main Station were completed. The excavation and disposal of excavation spoils of the main Station (levels 7, 8 and final excavation level),…
Μάθε Περισσότερα

May 2014

KORYDALLOS Station: The works for the general excavation of the Station and the works for the improvement of the foundation invert – placement of a drainage layer have been completed. Waterproofing works, the works for the placement of reinforcement and foundation slab concreting works are in progress. NIKEA Station: Excavation…
Μάθε Περισσότερα

April 2014

The works for the construction of cap beam, excavation and temporary retaining, temporary drainage of the raft and the construction of the foundation slab are completed, while waterproofing works and works for the construction of walls are in progress at AGHIA VARVARA Station; The worksite fencing, as well as the…
Μάθε Περισσότερα

March 2014

The works for the construction of the temporary retaining piles at AGHIA VARVARA Station are completed, while the works for the temporary discharge of the invert and the waterproofing works are in progress; The installation of the drainage layer on the invert of KORYDALLOS Station is in progress; The drainage…
Μάθε Περισσότερα

February 2014

The archaeological investigation trenches in Komninou Shaft were completed; The works for the construction of the foundation slab in AGHIA VARVARA Station are in progress; The general excavation works at the final level of KORYDALLOS Station are at an advanced stage; Shotcrete works up to the 8th level of NIKEA…
Μάθε Περισσότερα

January 2014

The general excavation (6th level) along with the temporary retaining structures in the area of KORYDALLOS Station are at a completion percentage of 89%; The worksite fencing in TAXIARCHON Shaft in AGHIA VARVARA Station is in progress; The main excavation works in the area of NIKEA Station (C/C) is at…
Μάθε Περισσότερα

December 2013

The works for the diversion of sewage and water supply networks at Komninou Shaft have been completed; The works for the construction of cap beam at AGHIA VARVARA Station are in advanced stage; The drilling, embedment and tensioning works of the prestressed anchors at KORYDALLOS Station are in progress; The…
Μάθε Περισσότερα
WCAG
