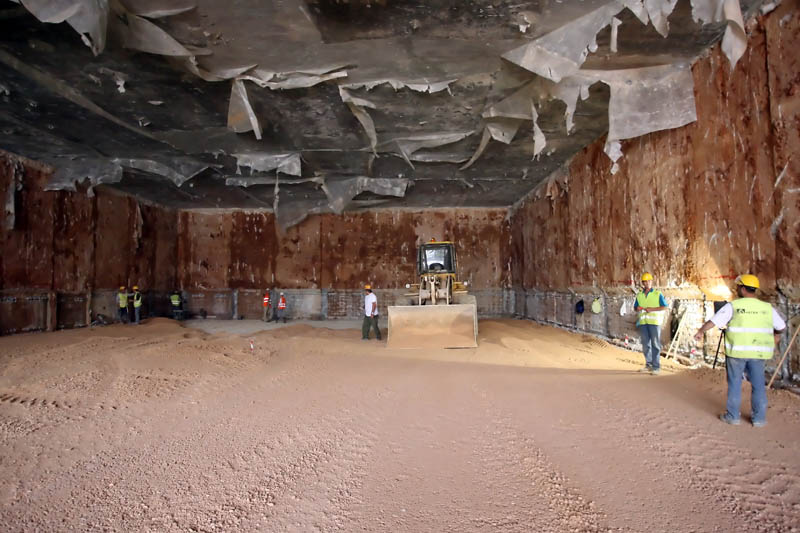

Thessaloniki Base Project progress

July 2009

The first Tunnel Boring Machine (ΤΒΜ1) has constructed 1450m of tunnel, while the second one (ΤΒΜ2) has constructed 950m. of parallel tunnel. Works related to the construction of diaphragm walls at EFKLEIDIS Station commenced. The construction of diaphragm walls at AGHIA SOFIA Station is at a completion stage (completed at a…
Μάθε Περισσότερα

June 2009

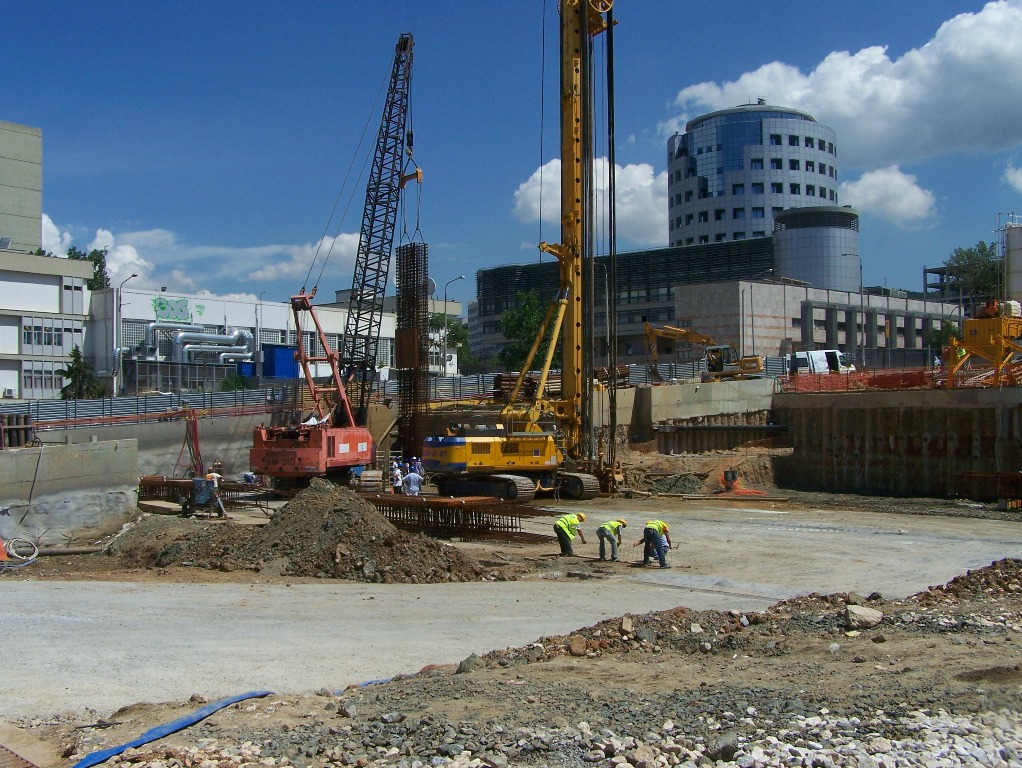

The first Tunnel Boring Machine (ΤΒΜ1) has constructed 1040m of tunnel, while the second one (ΤΒΜ2) has constructed 375m. of parallel tunnel. The construction of diaphragm walls at AGHIA SOFIA Station is at a completion stage (completed at a percentage of 82%), while diaphragm walls at PANEPISTIMIO Station commenced. PUO network…
Μάθε Περισσότερα

Μay 2009

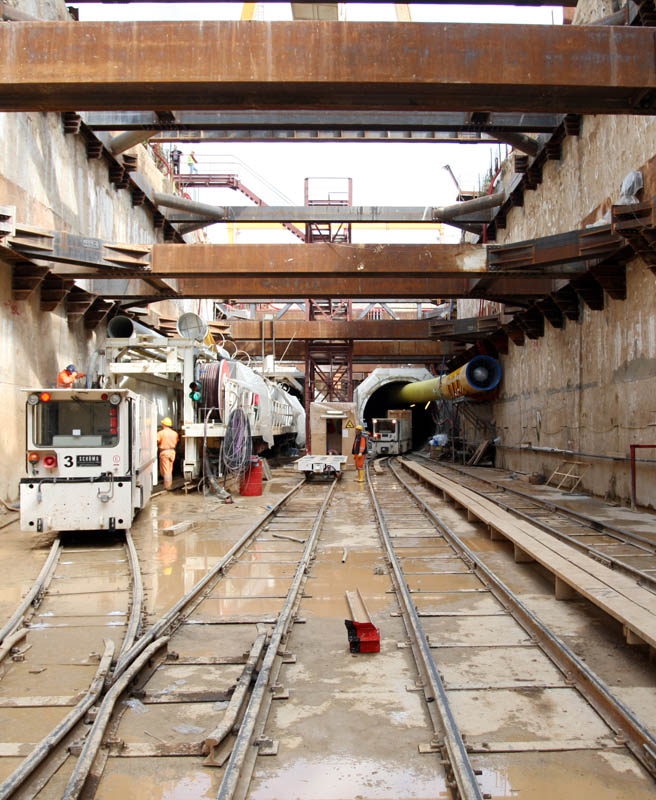

The first TBM (ΤΒΜ 1) has bored 800m. of tunnel, while the second one (ΤΒΜ 2) has constructed 200m. of parallel tunnel. The construction of diaphragm walls at NEO SIDIRODROMIKO STATHMO was completed, while at an advanced stage is the construction of diaphragm walls at AGHIA SOFIA Station (66%). Works…
Μάθε Περισσότερα

April 2009

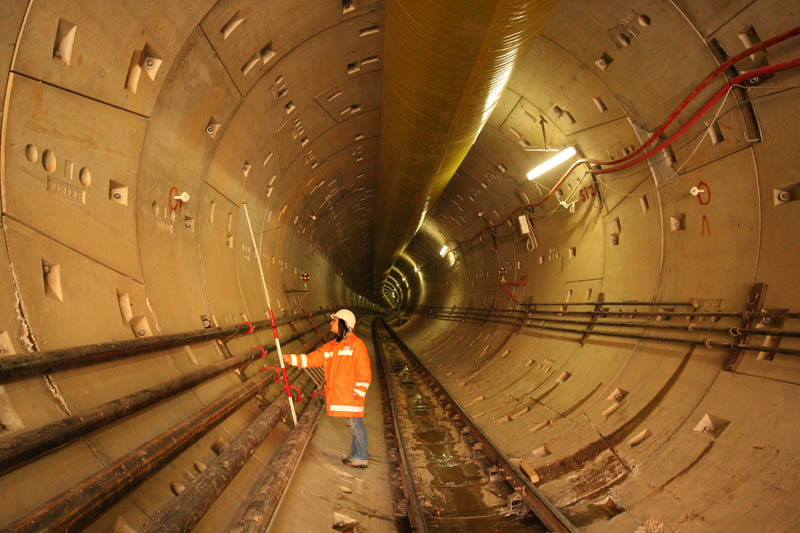

The first TBM has bored 600m. of tunnel, while on April 23rd the TBM named “Yorikas” started the construction of the second parallel tunnel. The construction of diaphragm walls at Neos Sidirodromikos Stathmos (completed at a percentage of 63%) and at Aghia Sofia Station (completed at a percentage of 63%)…
Μάθε Περισσότερα

March 2009

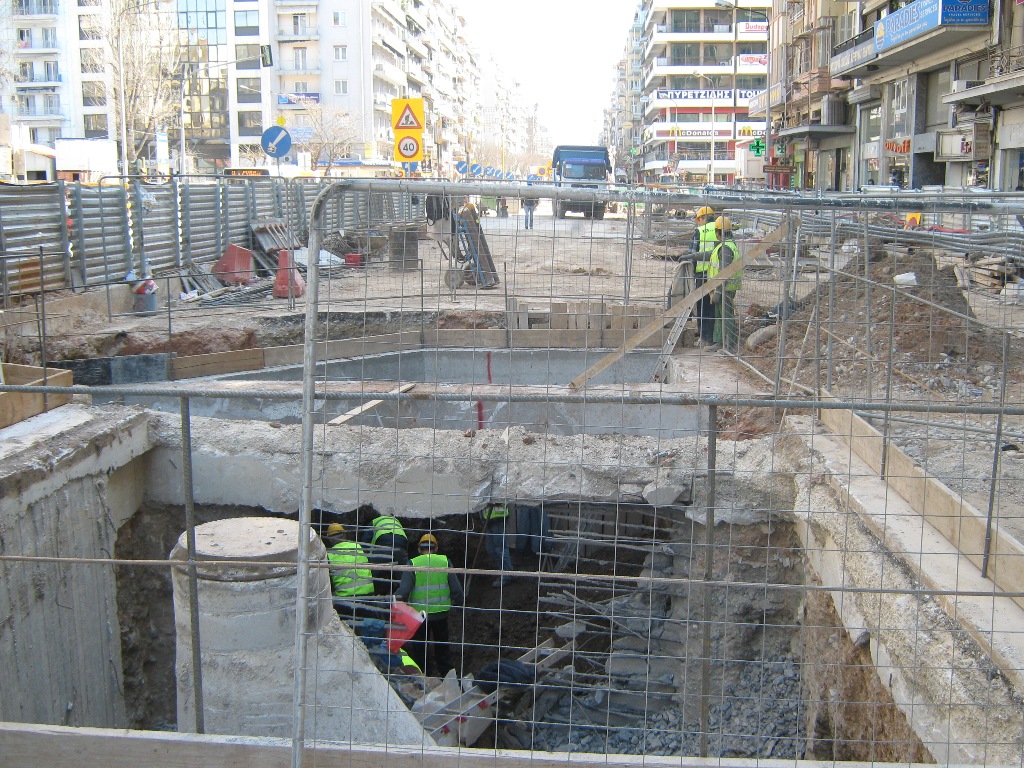

The assembly of the 2nd TBM was completed and its trial running commenced. The construction of diaphragm walls was completed at SYNTRIVANI Station, while it is in progress at NEOS SIDIRODROMIKOS STATHMOS (completed at a percentage of 43%). The worksite installation was completed at ANALIPSI Station and works related to…
Μάθε Περισσότερα

January 2009

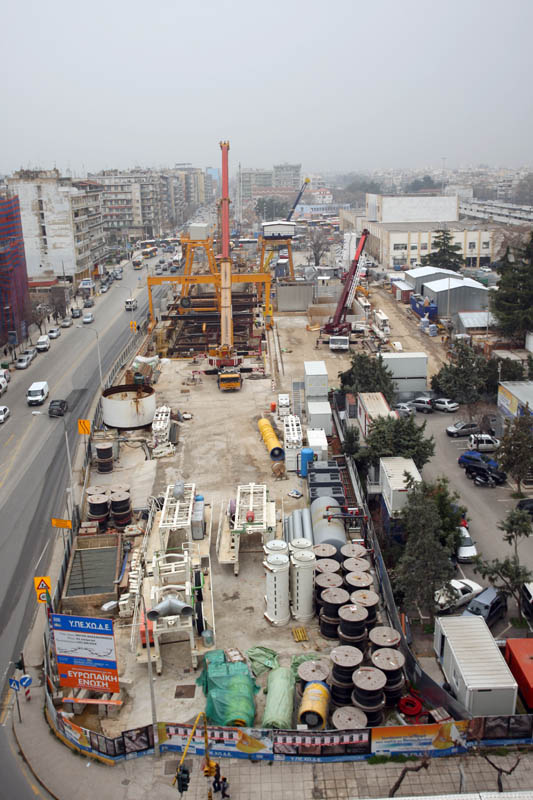

The running ot the first Tunnel Boring Machine commenced, while the assembly of the second TBM is in progress. The construction of diaphragm walls is at a completion stage: DEMOKRATIAS Station:completed at a percentage of 99% SYNTRIVANI Station:completed at a percentage of 81% Forestation of NEOS SIDIRODROMIKOS STATHMOS:completed at a…
Μάθε Περισσότερα

December 2008

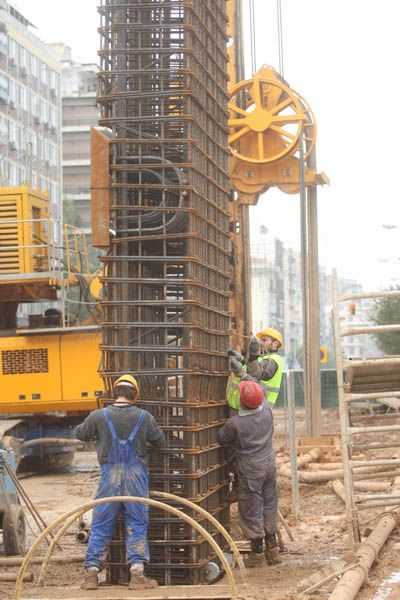

The trial running ot the first Tunnel Boring Machine commenced. The construction of diaphragm walls is at an advanced stage: Forestation of NEOS SIDIRODROMIKOS STATHMOS:completed at a percentage of 95% DEMOKRATIAS Station:completed at a percentage of 91% SYNTRIVANI Station:completed at a percentage of 92% AGHIA SOFIA Station:completed at a percentage of 51%…
Μάθε Περισσότερα

Νovember 2008

The assembly of the first Tunnel Boring Machine was completed. The construction of diaphragm walls is at an advanced stage: NEOS SIDIRODROMIKOS STATHMOS: completed at a percentage of 93% DEMOKRATIAS Station: completed at a percentage of 76% SYNTRIVANI Station: completed at a percentage of 91% AGHIA SOFIA Station: completed at…
Μάθε Περισσότερα

October 2008

The assembly of the first Tunnel Boring Machine is at a completion phase. The construction of diaphragm walls at Syntrivani will be completed soon (currently completed at a percentage of 86%). In the area where the orphanage “Alexander the Great” was located, excavation works commenced for the construction of a building…
Μάθε Περισσότερα
