Thessaloniki Base Project progress

May 2021

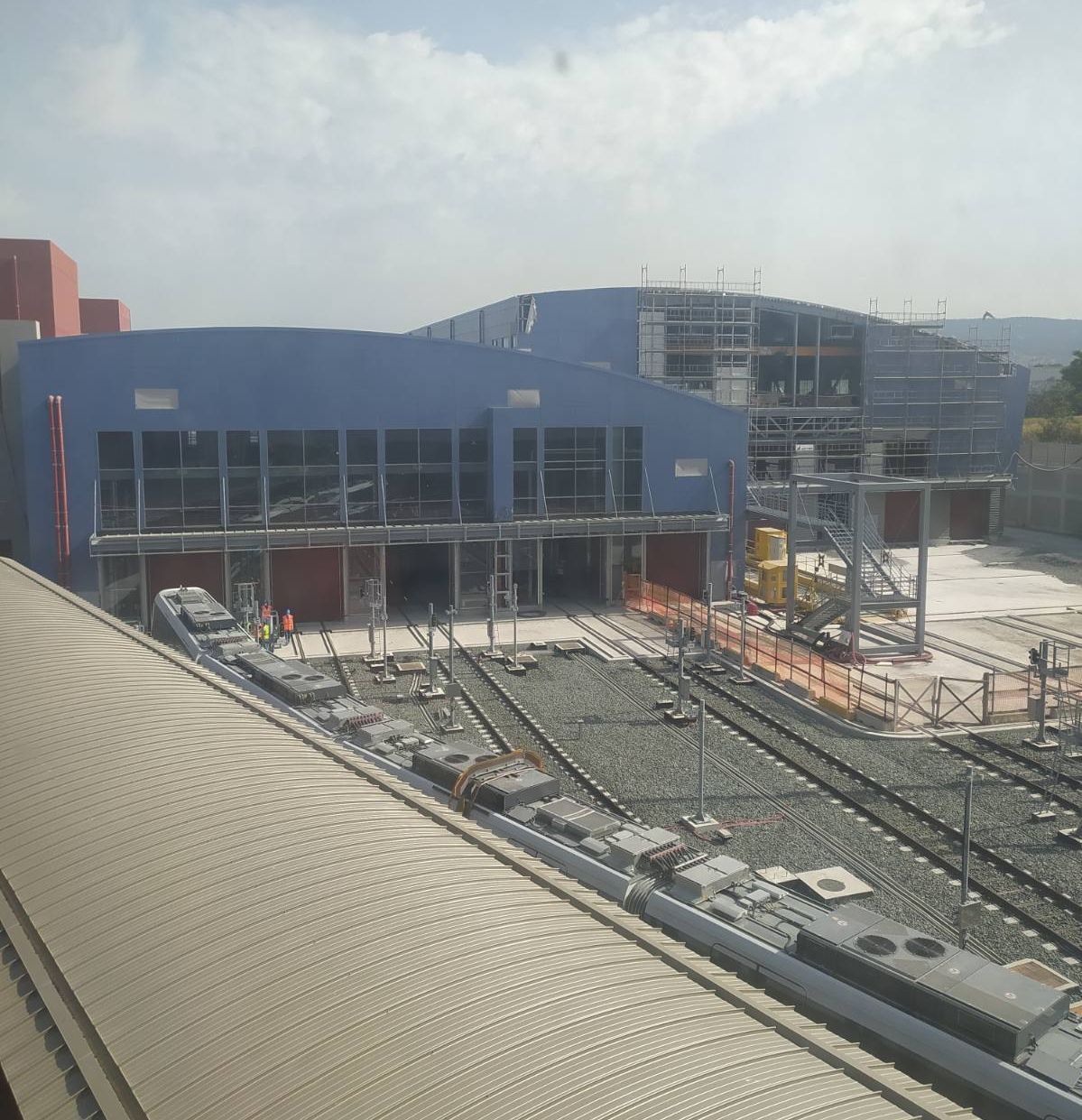

New Railway Station: In progress are vertical marble cladding works at level -1, works for the installation of fire-rated air ducts at platform level, as well as works for the configuration of the surrounding area, at the north part of the station. AGHIA SOFIA Station: In progress are masonry works at mezzanine…
Μάθε Περισσότερα

April 2021

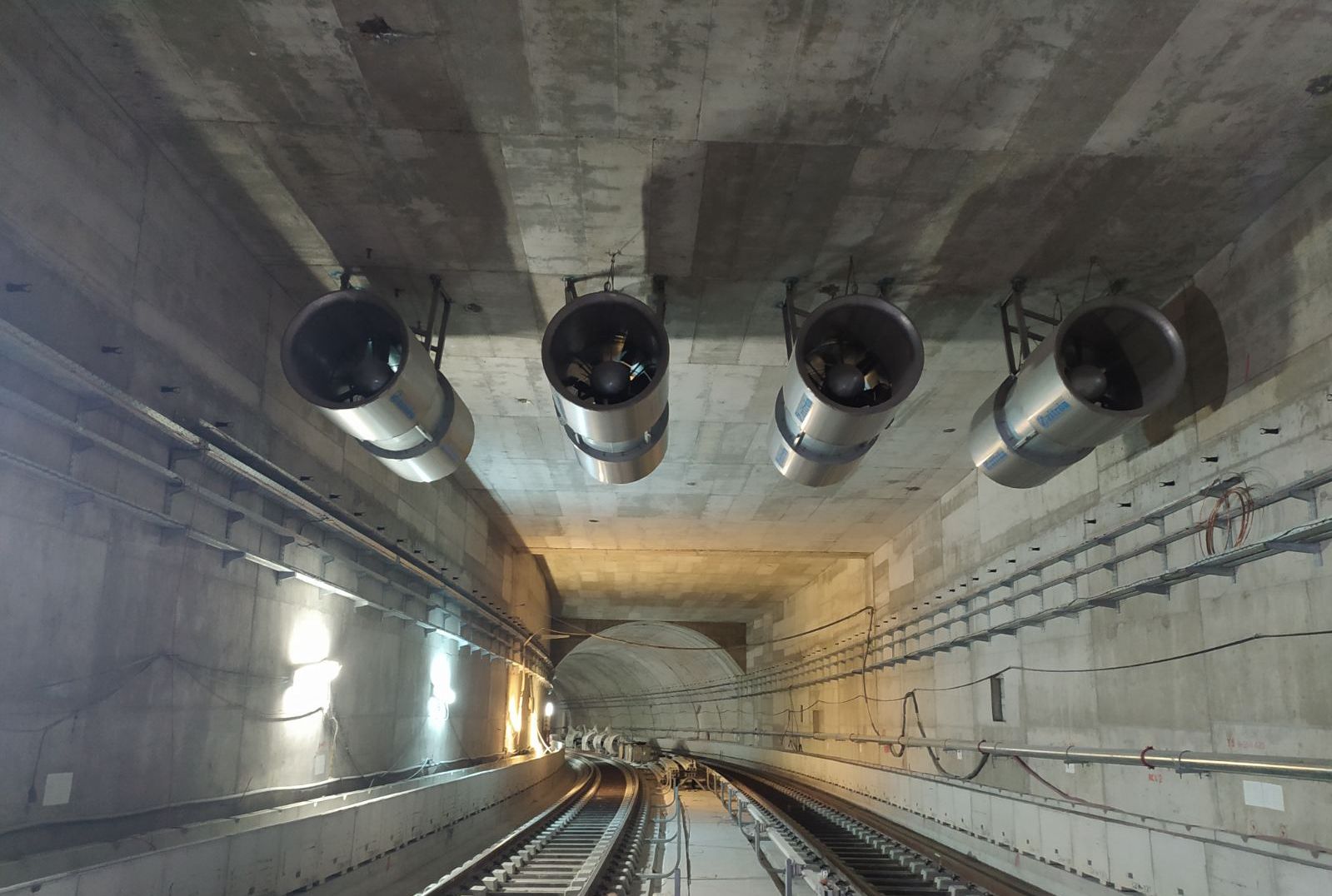

  New Railway Station: Works for the configuration of the surrounding area, at the north part of the station are in progress. DIMOKRATIAS Station: Granite installation works are in progress, at the staircases of the north and south access. SINTRIVANI Station (Station and Crossover): The works for the electrical connections…
Μάθε Περισσότερα

March 2021

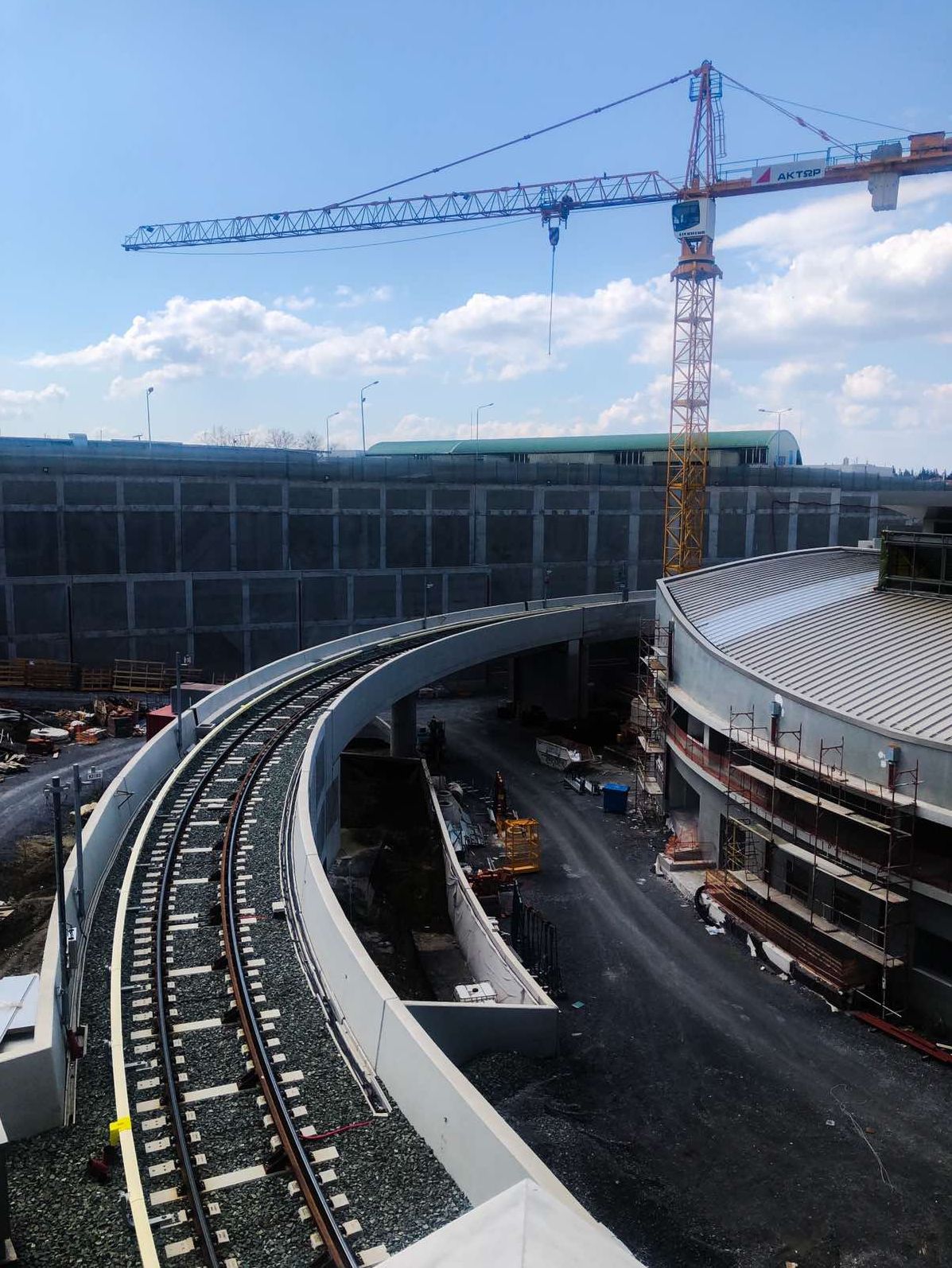

    New Railway Station: Works for the installation of cable trays at the signaling and telecommunications technical rooms have been completed. Works for the installation of equipment of the fire fighting system in tunnels are in progress. DIMOKRATIAS STATION: Works related to the installation of the air ducts network…
Μάθε Περισσότερα

February 2021

  New Railway Station: Works for the installation of cable trays at the signaling and telecommunications technical rooms are in progress. DIMOKRATIAS STATION: Works related to the installation of the air duct networks at level -1 are in progress. VENIZELOU Station: Archaeological excavations are in progress at the southern entrance.…
Μάθε Περισσότερα
ΒΑΣΙΚΟ ΕΡΓΟ - ΙΑΝΟΥΑΡΙΟΣ 2021

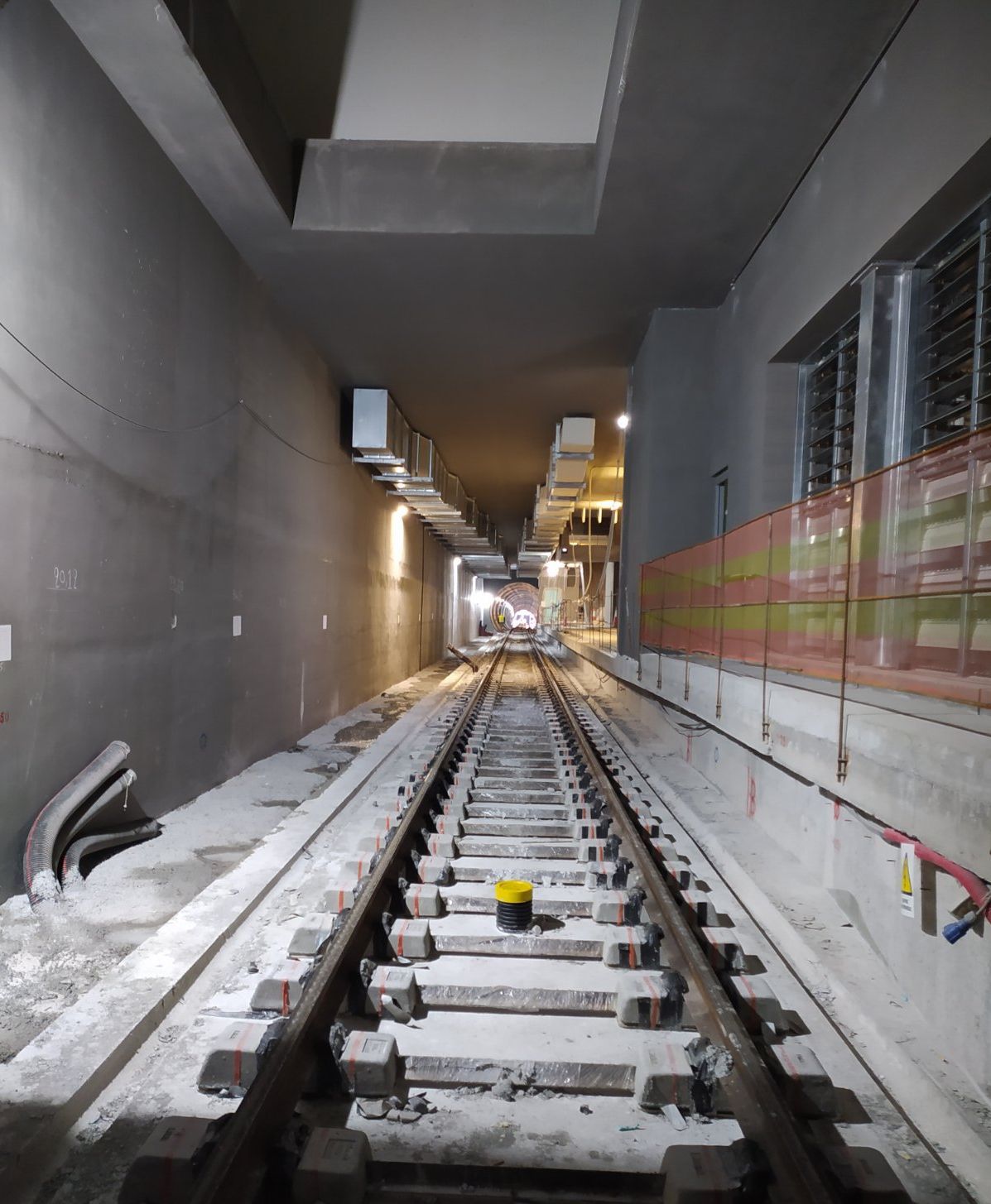

January 2021

    DIMOKRATIAS STATION: Works related to the installation of fire fighting, sewage and water supply networks at level -2 have been executed. AGHIA SOFIA Station: Preparatory works for the construction of masonry at levels -2 and -3 are in progress. SINTRIVANI Station: The works for the installation of sub-frames…
Μάθε Περισσότερα
THESSALONIKI_12_20

December 2020

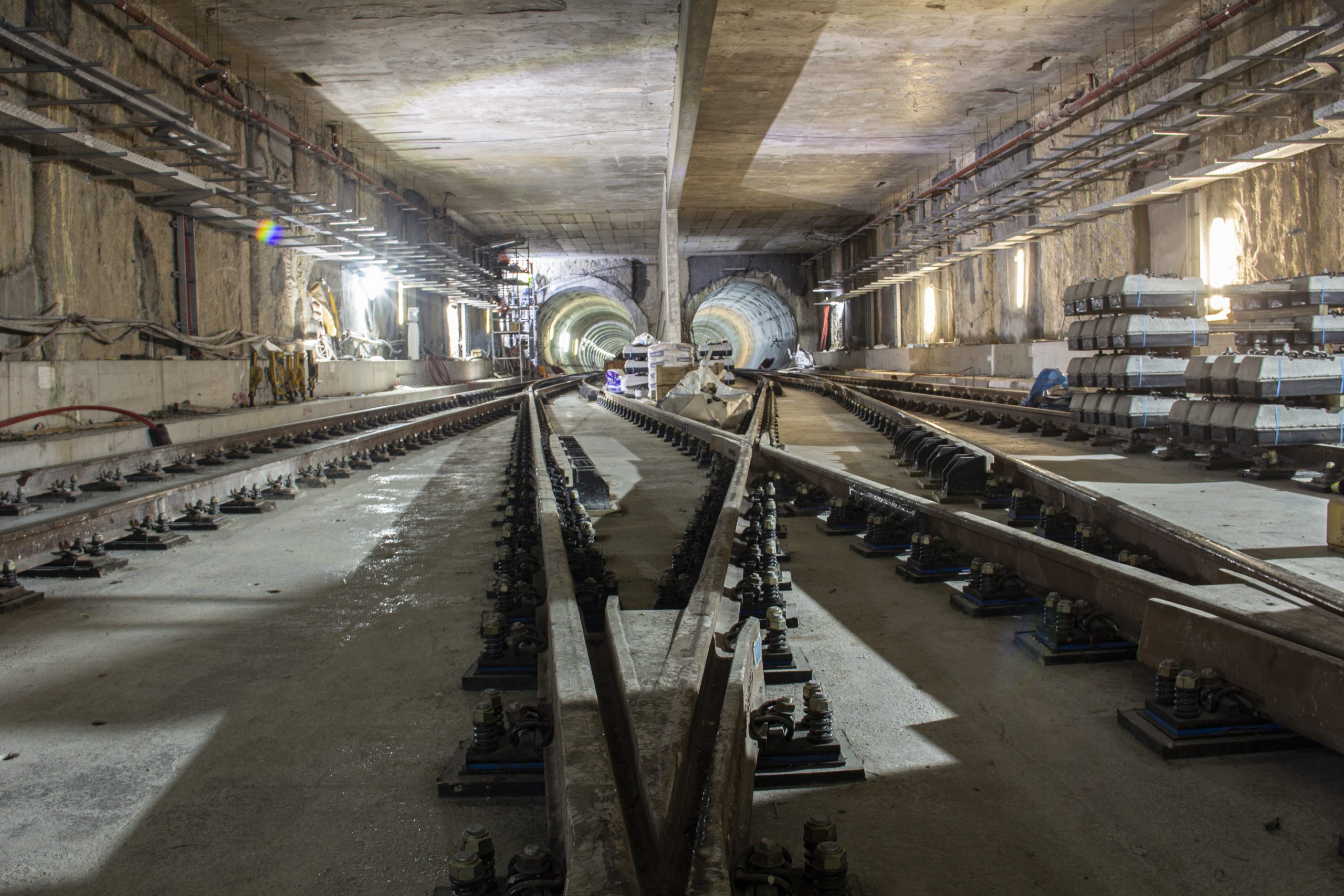

  NEW RAILWAY STATION: Works related to the construction of masonry walls and plastering related works have been executed. VENIZELOU Station: The works for the removal of the equipment and installations at the south access have been completed. AGHIA SOFIA Station: Works for the construction of parapet walls’ terminations at…
Μάθε Περισσότερα

November 2020

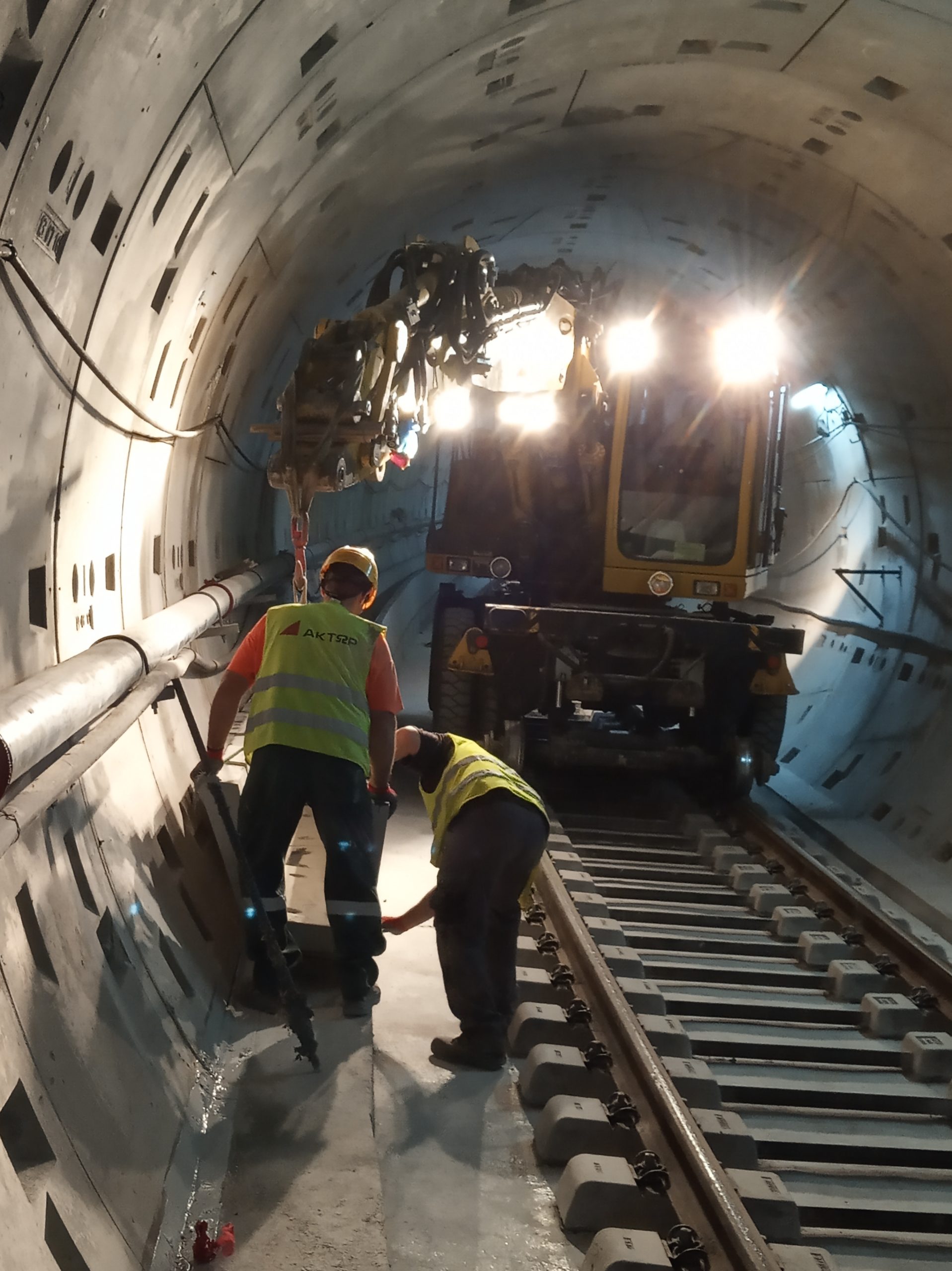

  DIMOKRATIAS Station: In progress are works for the installation of the air duct network at level -2. VENIZELOU Station: Diaphragm walls construction works at the southern access, as well as works related to roof slab supporting piles have been completed. AGHIA SOFIA Station: Works for the construction of parapet…
Μάθε Περισσότερα
Πρόοδος Βασικού Έργου Θεσσαλονίκης - Οκτώβριος 2020

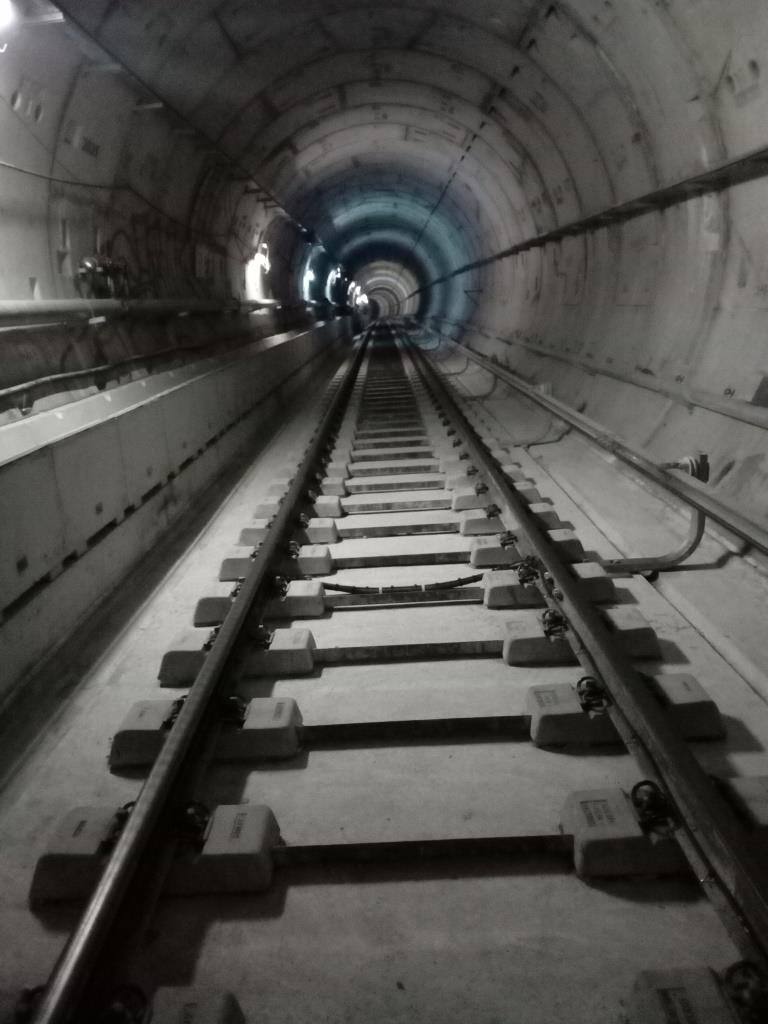

October 2020

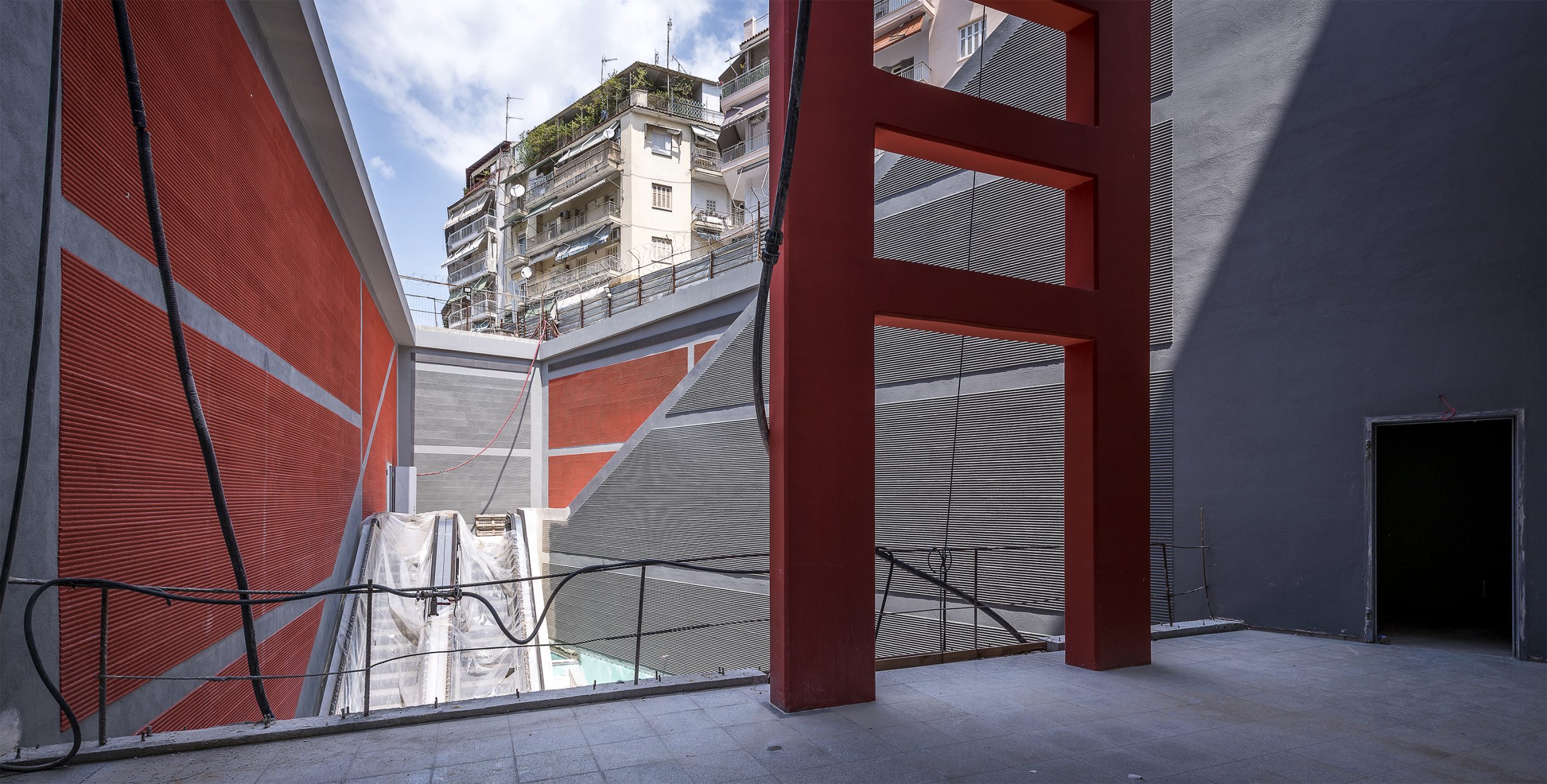

  VENIZELOU Station: Diaphragm walls construction works at the southern access have been completed. In progress are equipment and related facilities removal works, as well as works for the construction of temporary retaining piles at the southern access. AGHIA SOFIA Station:  Surface reinstatement works at the south section of the…
Μάθε Περισσότερα
Πρόοδος βασικού έργου Θεσσαλονίκης - Σεπτέμβριος 2020

September 2020

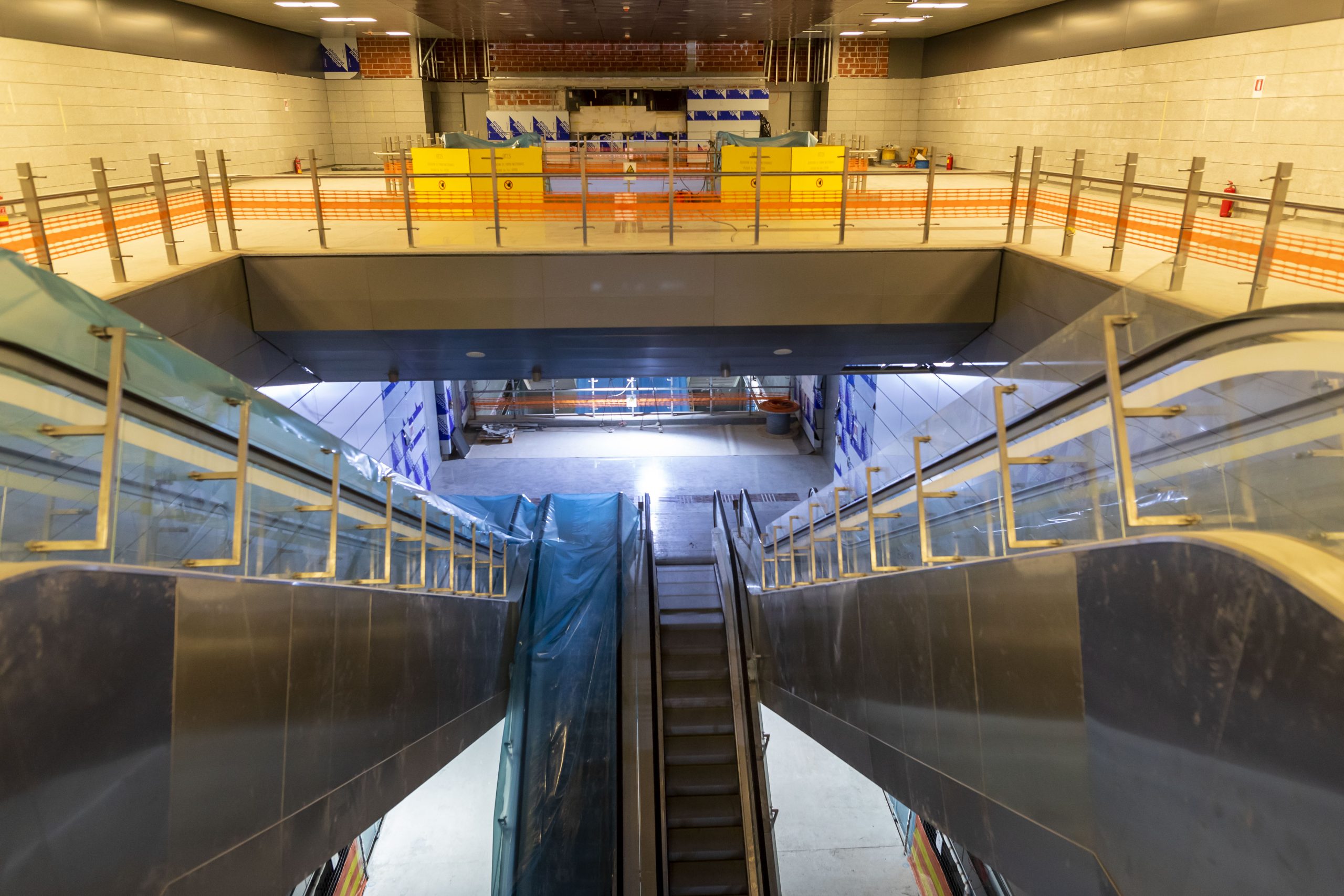

  NEW RAILWAY Station: Works for the installation of E/M equipment bases and works for the installation of sewage and fire fighting networks have been executed. DIMOKRATIAS Station: Works for the installation of E/M equipment bases have been executed. AGHIA SOFIA Station: Works for the construction of the permanent lining…
Μάθε Περισσότερα
