Thessaloniki Base Project progress

OCTOBER 2018

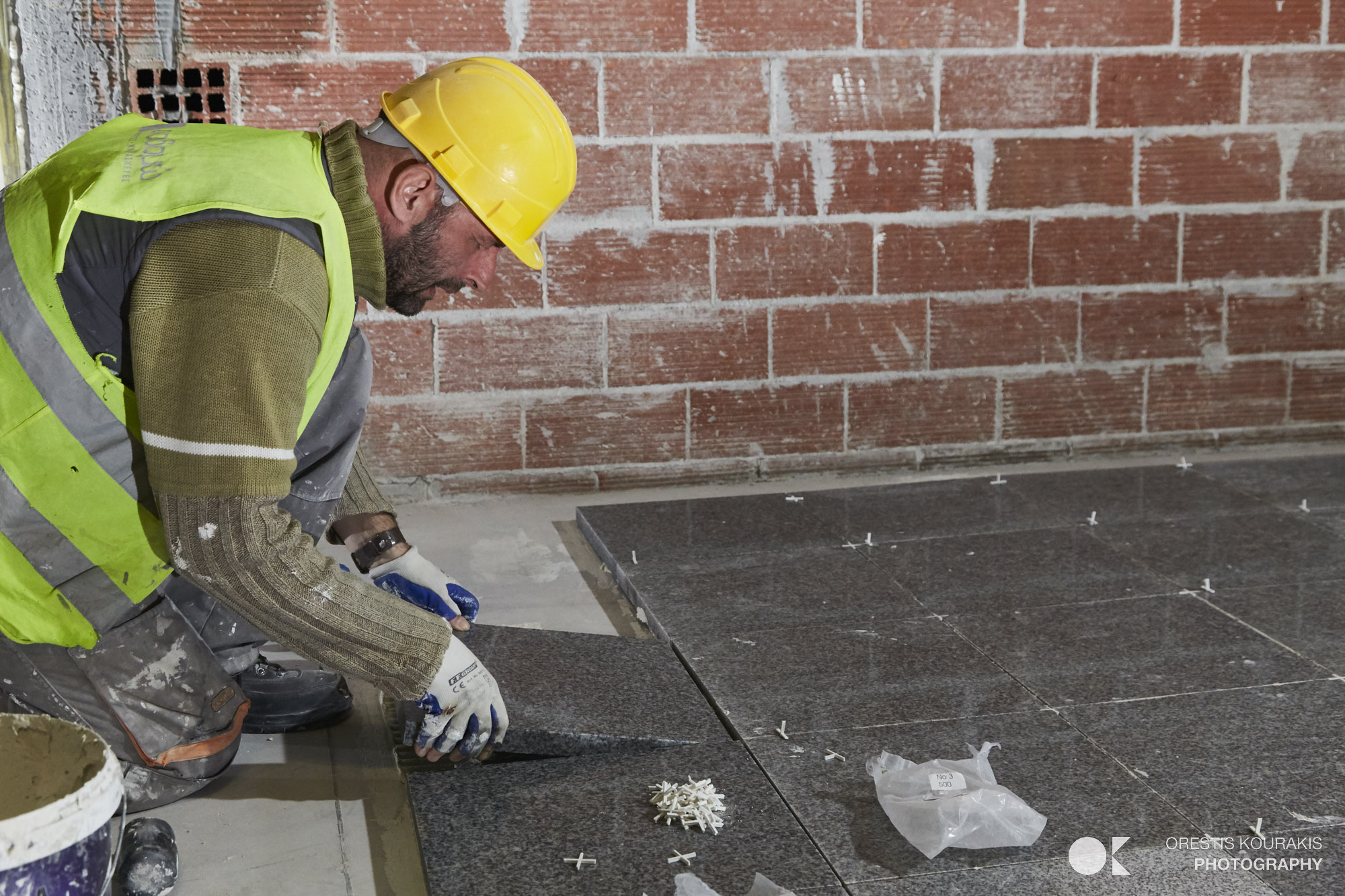

NEW RAILWAY Station: The works for the construction of indoor partitions are in progress. DIMOKRATIAS Station (Station and Crossover): The works for closing the southern opening, as well as for the reinstatement of the southern sidewalk of Monastiriou street are in progress. Works related to the implementation of the next…
Μάθε Περισσότερα

SEPTEMBER 2018

NEW RAILWAY Station: The works for the installation of E/M systems (fire extinguishing, water supply), as well as the construction of indoor partitions, are in progress. DIMOKRATIAS Station (station and crossover): The works for the installation of doors at the station and well as painting works are in progress. VENIZELOU…
Μάθε Περισσότερα

AUGUST 2018

Base Project NEW RAILWAY Station: the configuration of the surrounding area is in progress. DIMOKRATIAS Station (station and crossover): The works for the reinstatement of the south sidewalk of Monastiriou Street, as well as the subsequent traffic arrangement, are in progress. VENIZELOU Station: The necessary works for the subsequent traffic…
Μάθε Περισσότερα

June 2018

• NEW RAILWAY Station: E/M installations in progress (water network). • DIMOKRATIAS Station: The installation of metal doors at levels -1 and -2 of the station and the backfilling of the south access of the station are completed. The construction of the station’s walls and the implementation of traffic regulation…
Μάθε Περισσότερα

May 2018

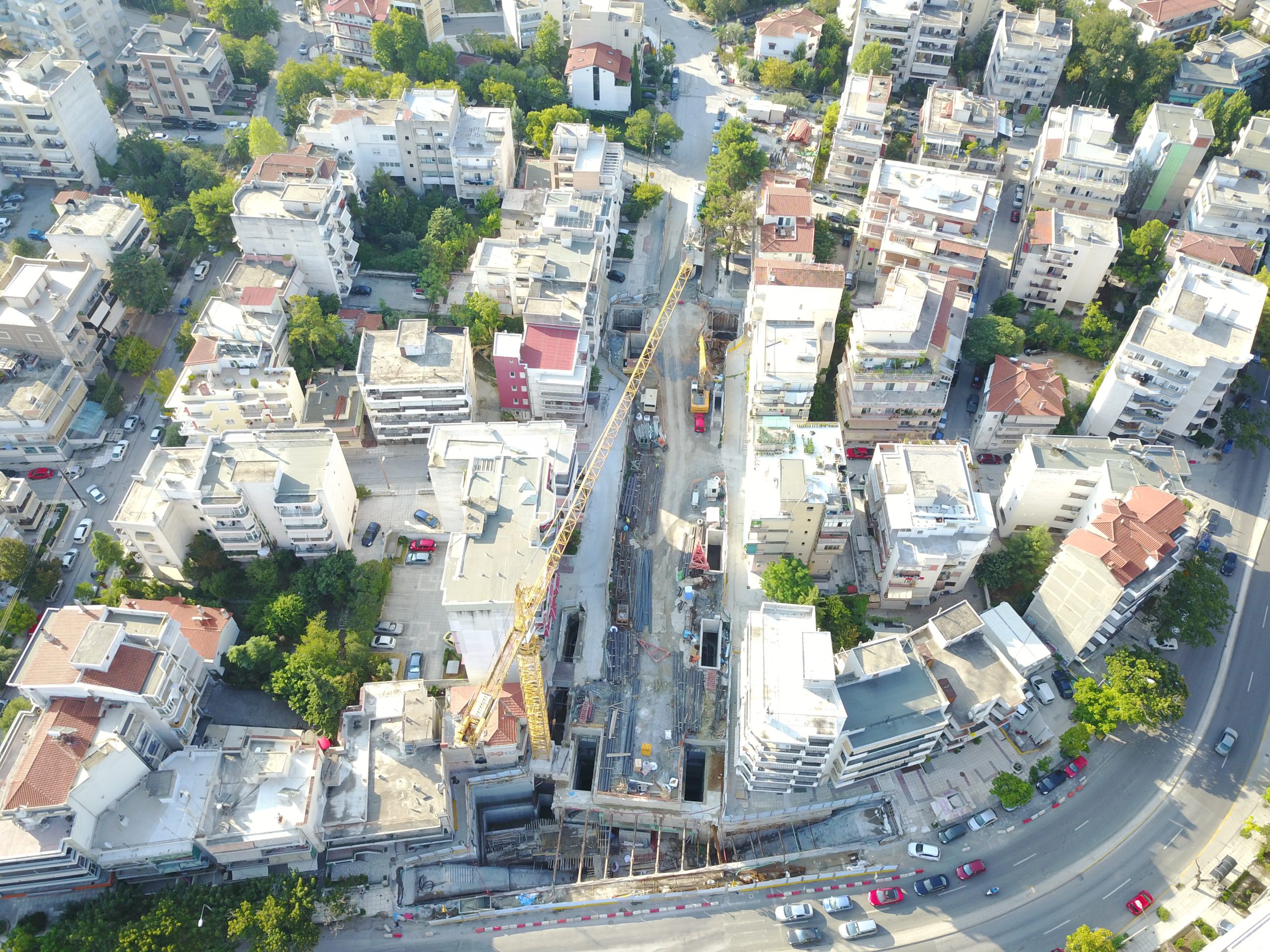

NEW RAILWAY Station: the configuration of the surrounding area is in progress. • DIMOKRATIAS Station: The installation of metal doors at levels -1 and -2 of the station and the backfilling of the south access of the station are completed. The construction of the station’s walls and the implementation of…
Μάθε Περισσότερα

February 2018

[responsivevoice_button voice=”UK English Female” buttontext=”Listen to post”] NEW RAILWAY Station: Implementation of traffic phase E’, as well as plastering and masonry wall related works have been completed. The works for the construction of shaft terminations are in progress. • AGHIA SOFIA Station – north access: The archaeological excavation in progress.…
Μάθε Περισσότερα

January 2018

NEW RAILWAY Station: The installation of escalators at the accesses has been completed. In progress are works for the implementation of traffic phase E’, as well as the works for the installation of doors and E/M installations (sewage network). • DIMOKRATIAS Station: The construction of the north access and the…
Μάθε Περισσότερα

April 2017

• NEW RAILWAY Station: The archaeological excavation at the south shafts is complete. The excavation and the temporary retaining of the southern shaft are in progress. • DIMOKRATIAS Station: The construction of the temporary retaining at the southern access is in progress. • SINTRIVANI Station – EXPO: The construction of…
Μάθε Περισσότερα

December 2016

• Dimokratias Crossover: Works for the construction of the foundation slab at the northern part have been completed. • SINTRIVANI Crossover: Works for the concreting of provisional openings are in progress. • PANEPISTIMIO Station: Works for the construction of masonry walls at level -1 have commenced. • PAPAFI Station: Works…
Μάθε Περισσότερα
