Web Portal - Elliniko Metro A.E.
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa

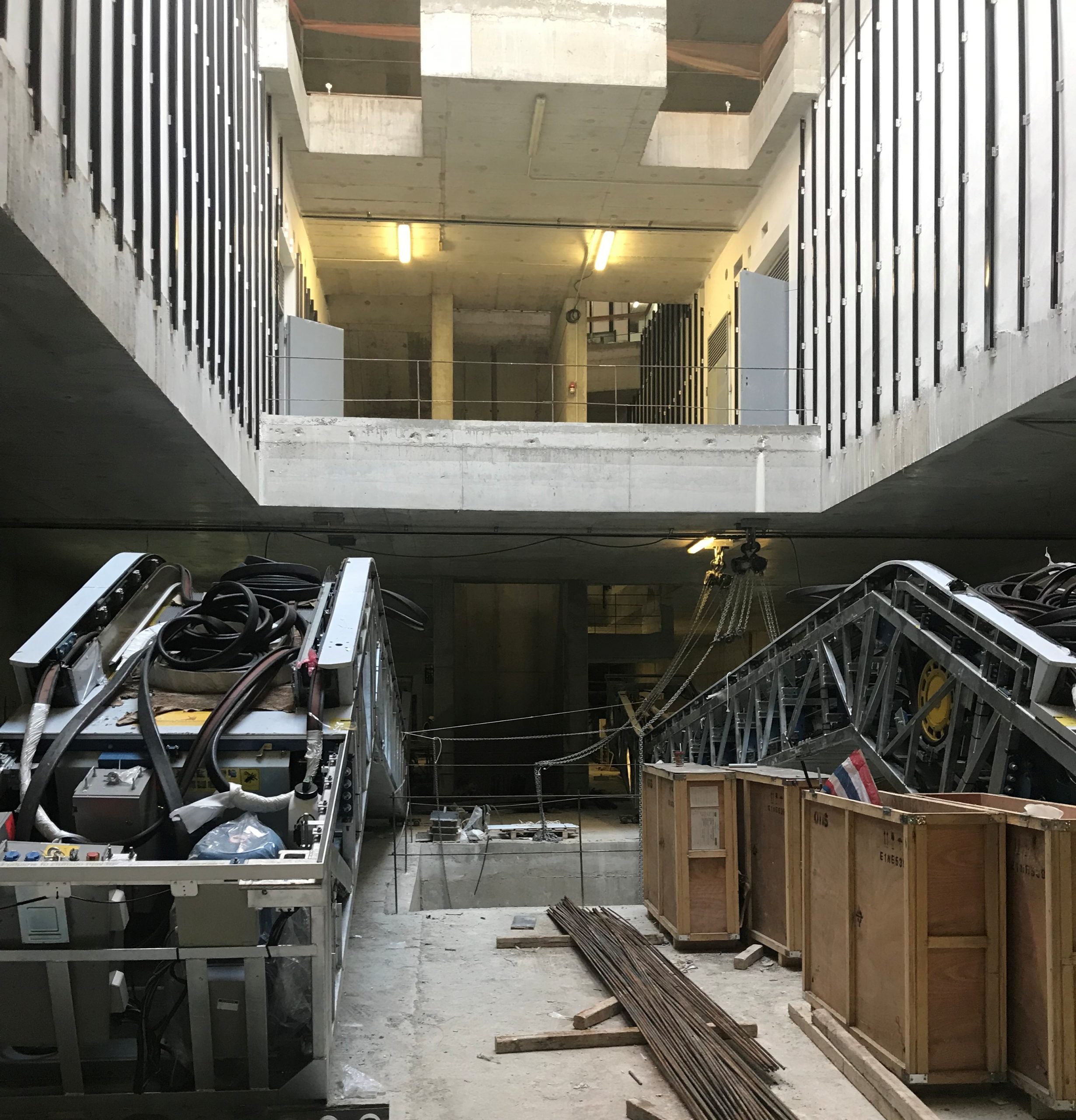

Kalamaria Project progress

November 2019

NOMARCHIA Station: The works for the reinstatement of PUO networks and the configuration of the surrounding area are in progress. KALAMARIA Station: The following works are in progress: painting works at track level, backfilling of the surrounding area and reinstatement of PUO networks. ARETSOU Station: The works for the construction…
Μάθε Περισσότερα

October 2019

Kritis Shaft: The works for the construction of the permanent lining are in progress. NOMARCHIA Station: The works for the construction of the terminations of shafts and their painting works have been completed. The works for the installation of granites at the platform and the construction of metal elements in…
Μάθε Περισσότερα

May 2019

NOMARCHIA Station: Wall cladding works using fiber cement boards, as well as painting works are in progress. KALAMARIA Station: Cladding works in public areas using granite are in progress. ARETSOU Station: Cladding works at staircases using granite slabs, as well as works related to backfilling and surface reinstatement are in…
Μάθε Περισσότερα

January 2019

NOMARCHIA Station: Architectural works and works for the installation of E/M systems are in progress. KALAMARIA Station: The works for the construction of the east access, as well as the architectural and E/M installation works are in progress. ARETSOU Station: Architectural and E/M installation works are in progress. NEA KRINI…
Μάθε Περισσότερα

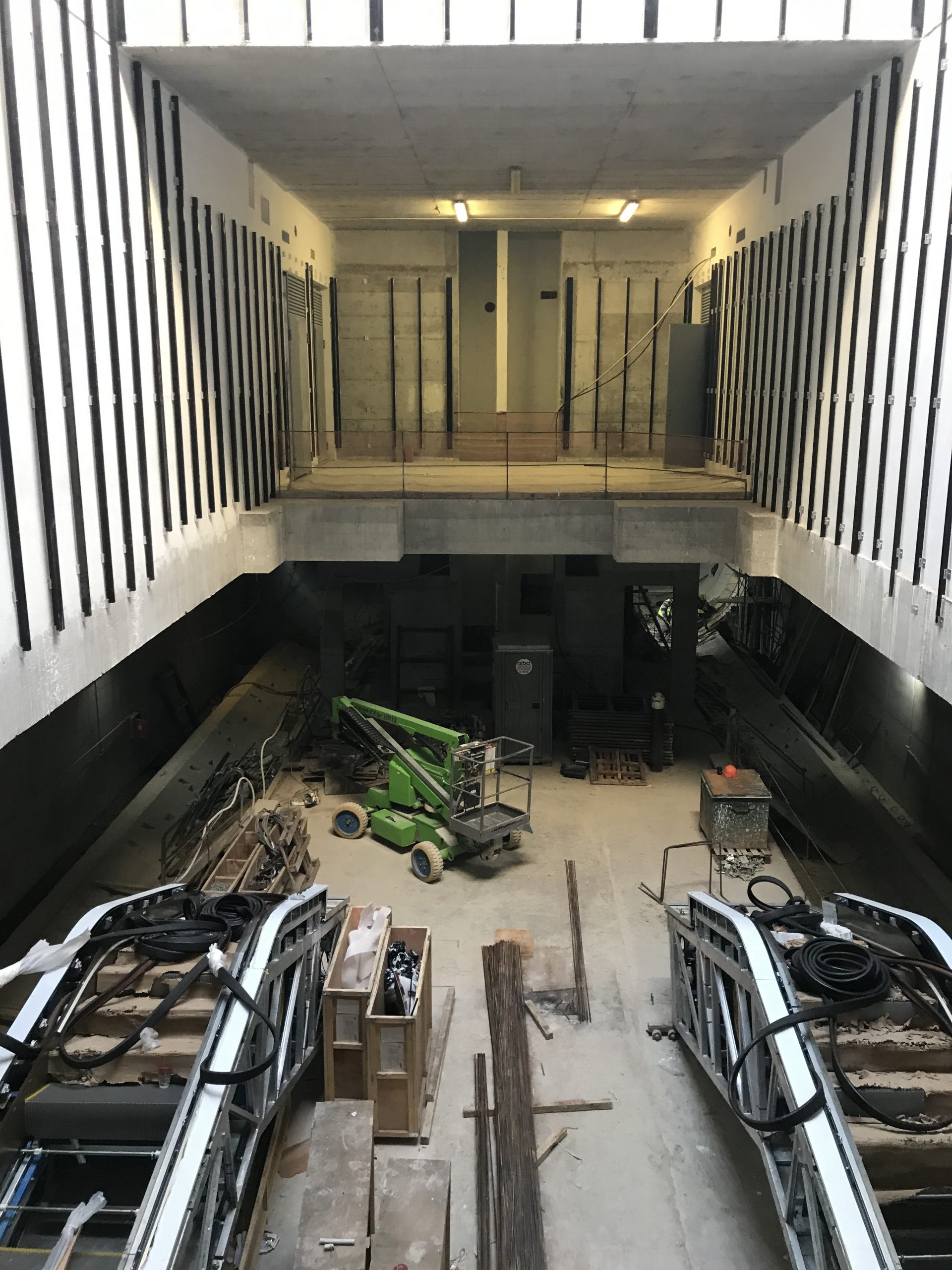

DECEMBER 2018

NOMARCHIA Station: Floor cladding works using granite slabs are in progress, while E/M installation works are at an initial stage. KALAMARIA Station: Painting works are at an initial stage, while works for the construction of the platform and the construction of the north ventilation shaft have commenced. ARETSOU Station: Floor…
Μάθε Περισσότερα

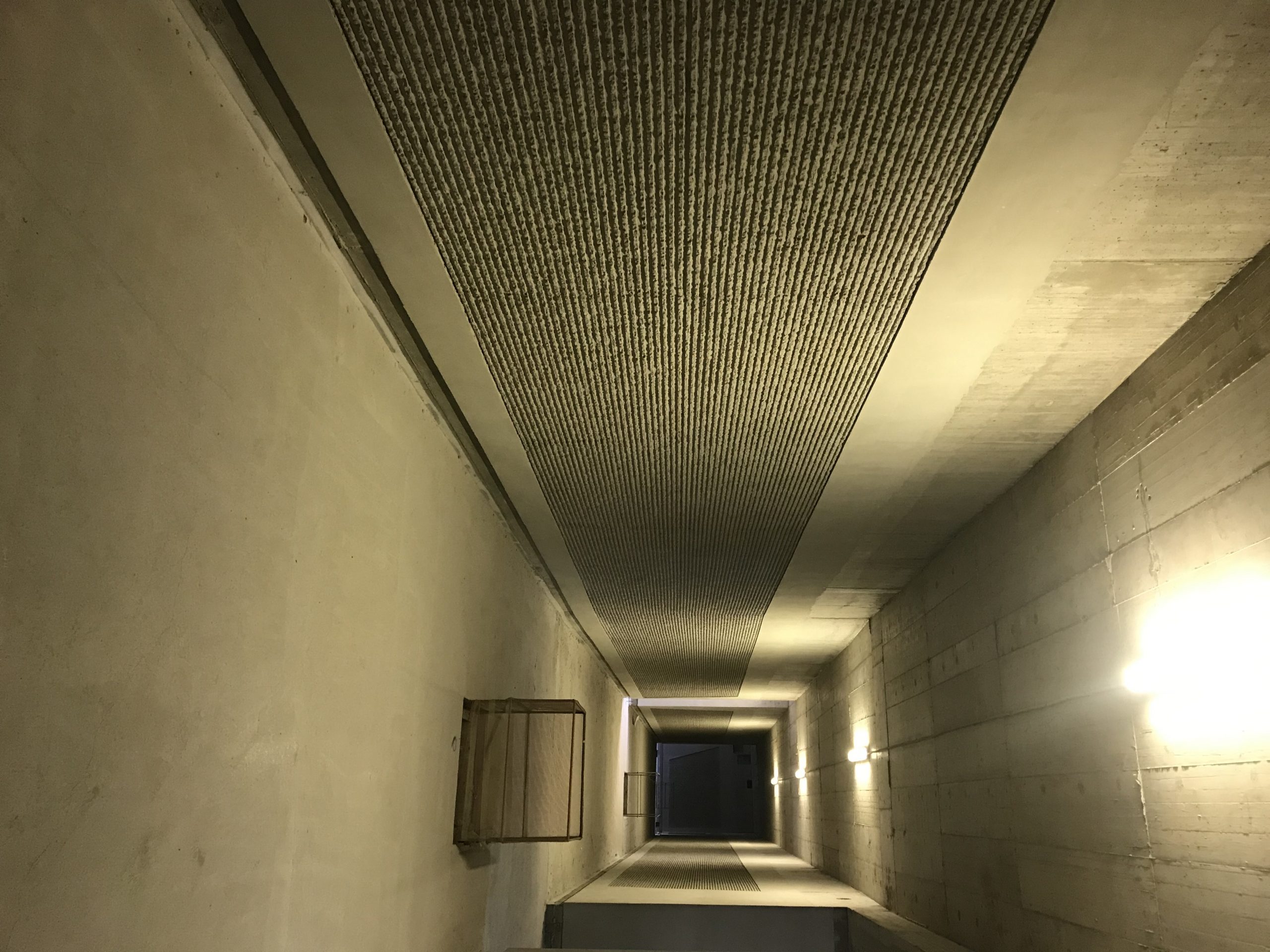

NOVEMBER 2018

Kritis shaft: The works for the construction of the connecting tunnels are in progress. NOMARCHIA Station: Platform construction works have been completed, while works for the installation of indoor escalators are in progress. KALAMARIA Station: The works for the construction of the south ventilation shaft have been completed, while works…
Μάθε Περισσότερα

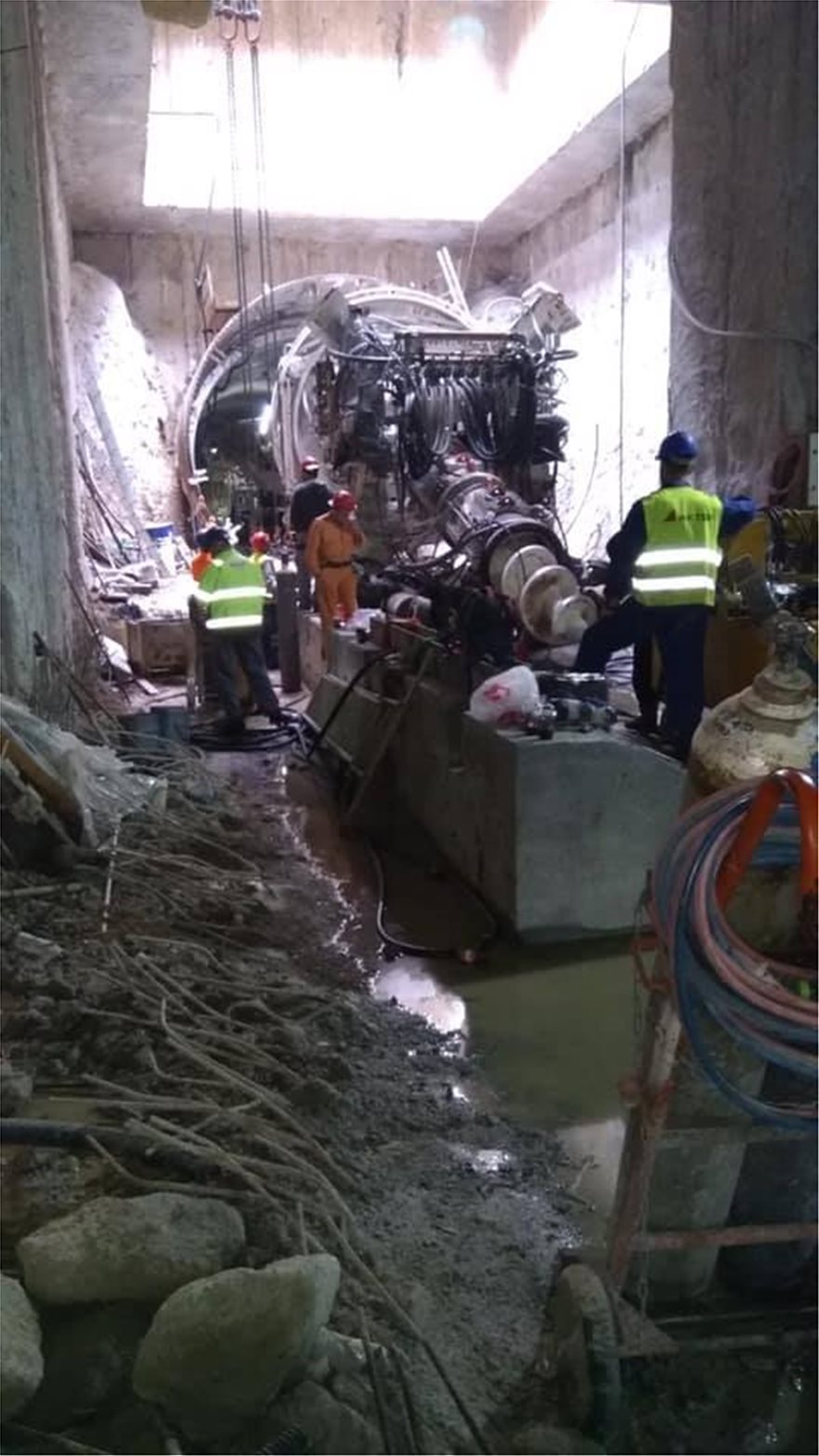

OCTOBER 2018

Kritis shaft: The works for the construction of the connecting tunnels are in progress. NOMARCHIA Station: The painting works are completed. KALAMARIA Station: The works for the permanent lining of the eastern access of the Station are in progress. ARETSOU Station: The works for the concreting and waterproofing of the…
Μάθε Περισσότερα

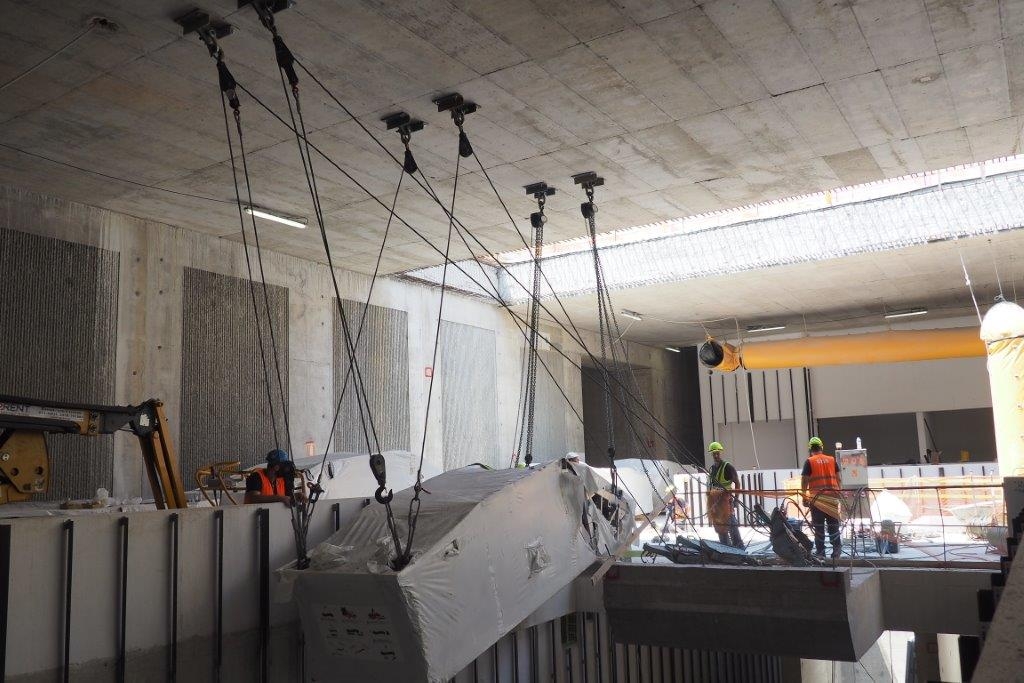

SEPTEMBER 2018

Kritis shaft: The works for the construction of the perimeter permanent lining continue, while the works for the construction of connecting tunnels are in progress. NOMARCHIA Station: The works for the construction of platforms are at an advanced stage, while the works for the construction of the lining of indoor…
Μάθε Περισσότερα

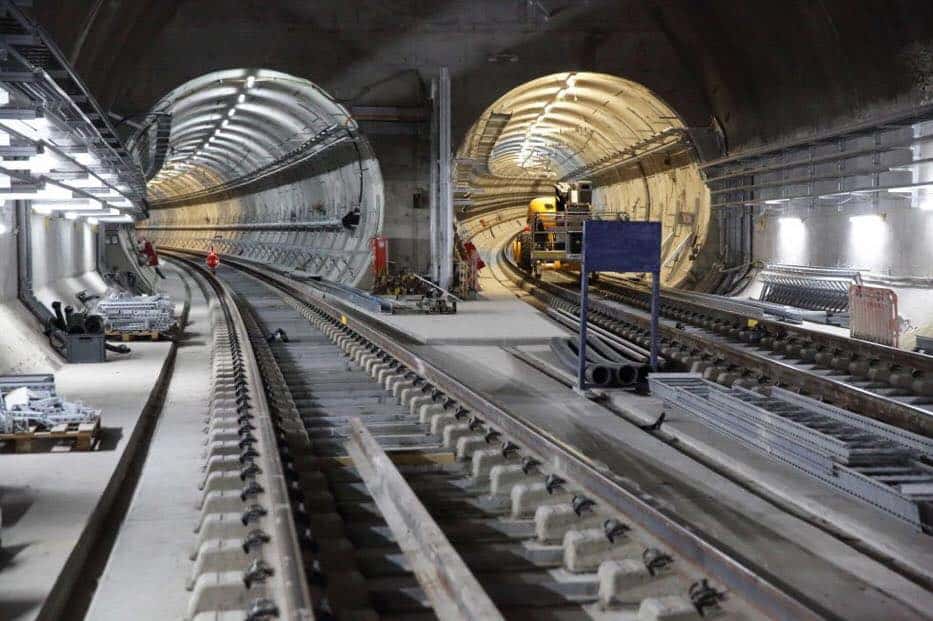

AUGUST 2018

Kritis shaft: The works for the construction of forepoles have been completed. NOMARCHIA Station: The works for the construction of the platform are in progress. KALAMARIA Station: Waterproofing works, as well as works for the permanent lining of the east access and pits, are in progress. ARETSOU Station: In progress…
Μάθε Περισσότερα

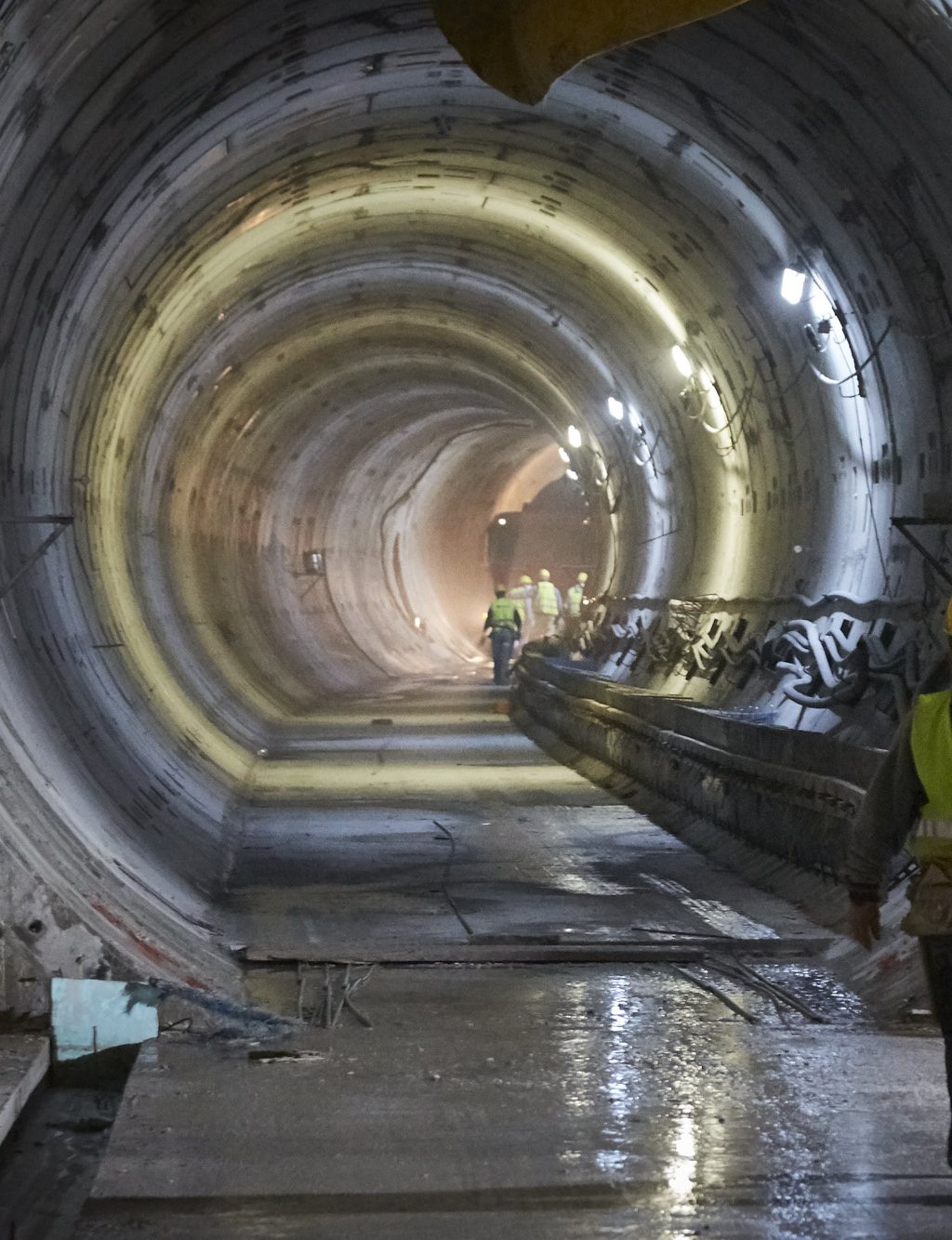

June 2018

• Kritis shaft: The permanent lining of the pumping station is completed. • NOMARCHIA Station: The permanent lining at section 7 of the perimeter structures (ventilation shafts) and the backfilling and construction of the PUO networks in the area of the north access have been completed. Granite flooring, phase D1…
Μάθε Περισσότερα
WCAG
