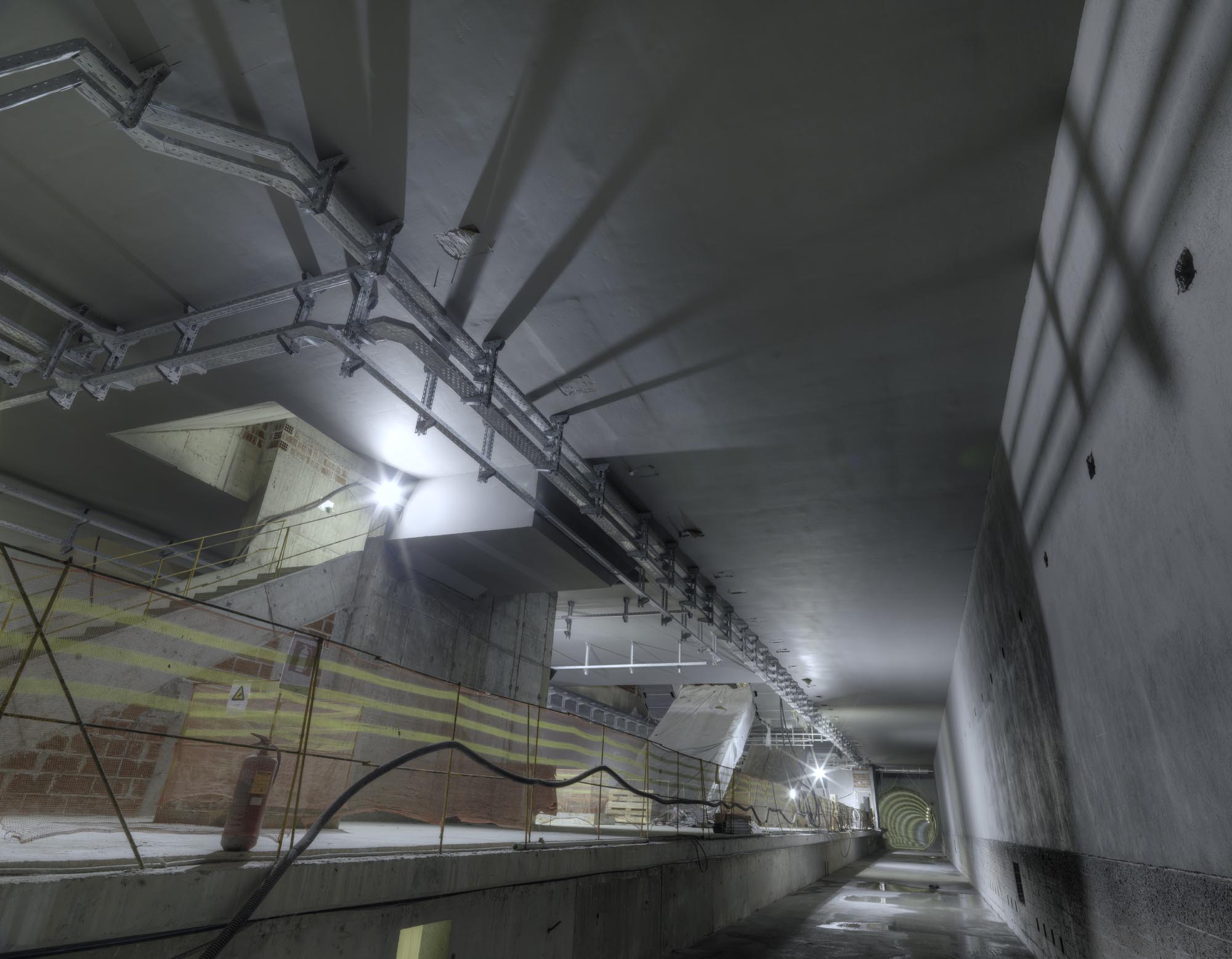

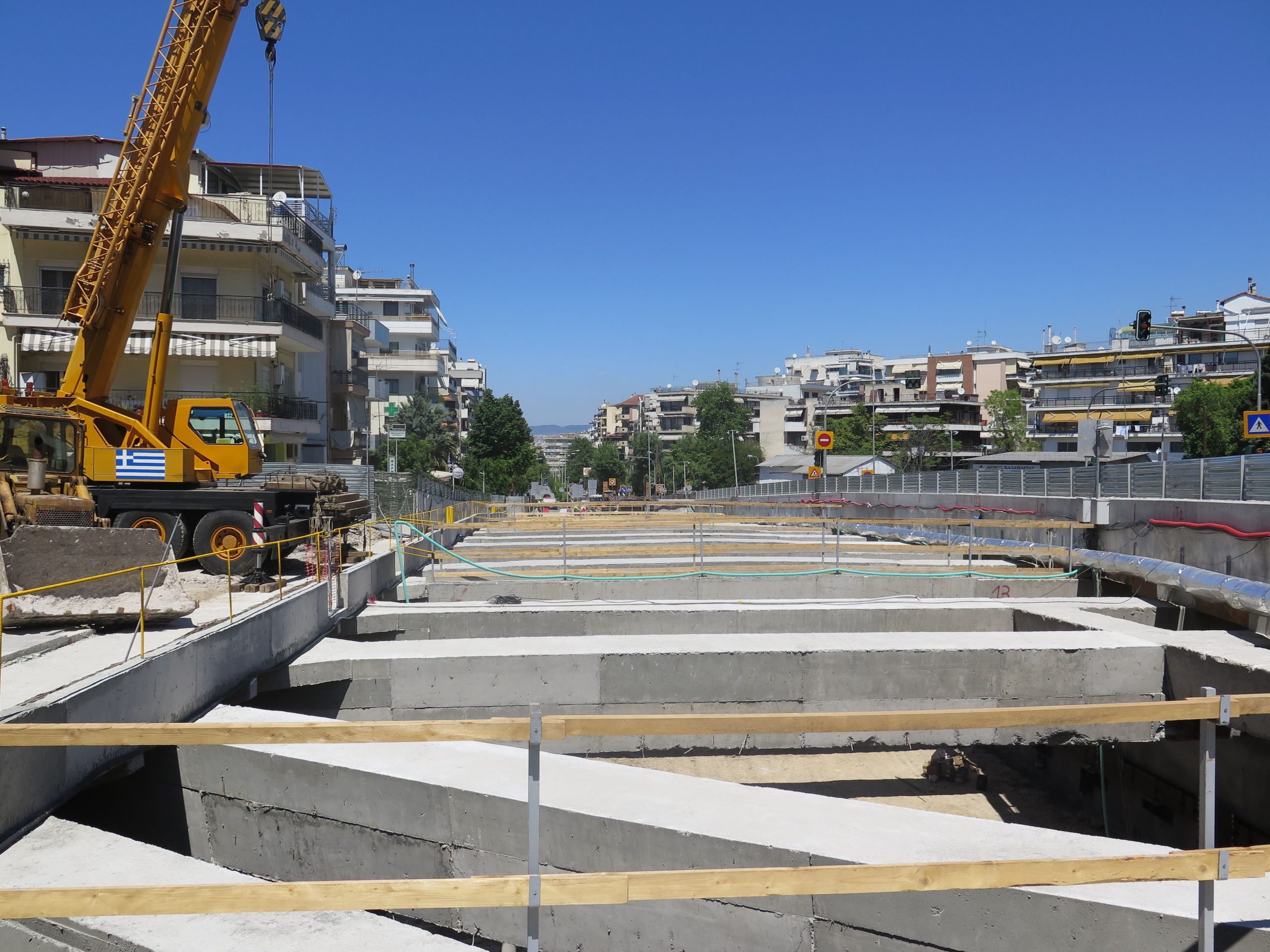

Kalamaria Project progress

May 2018

Kritis shaft: The excavation and temporary retaining of the pumping station have been completed. • NOMARCHIA Station: Completed are the construction of the permanent lining of the north access, as well as the construction of industrial floors at level -2. The backfilling and construction of PUO networks in the area…
Μάθε Περισσότερα

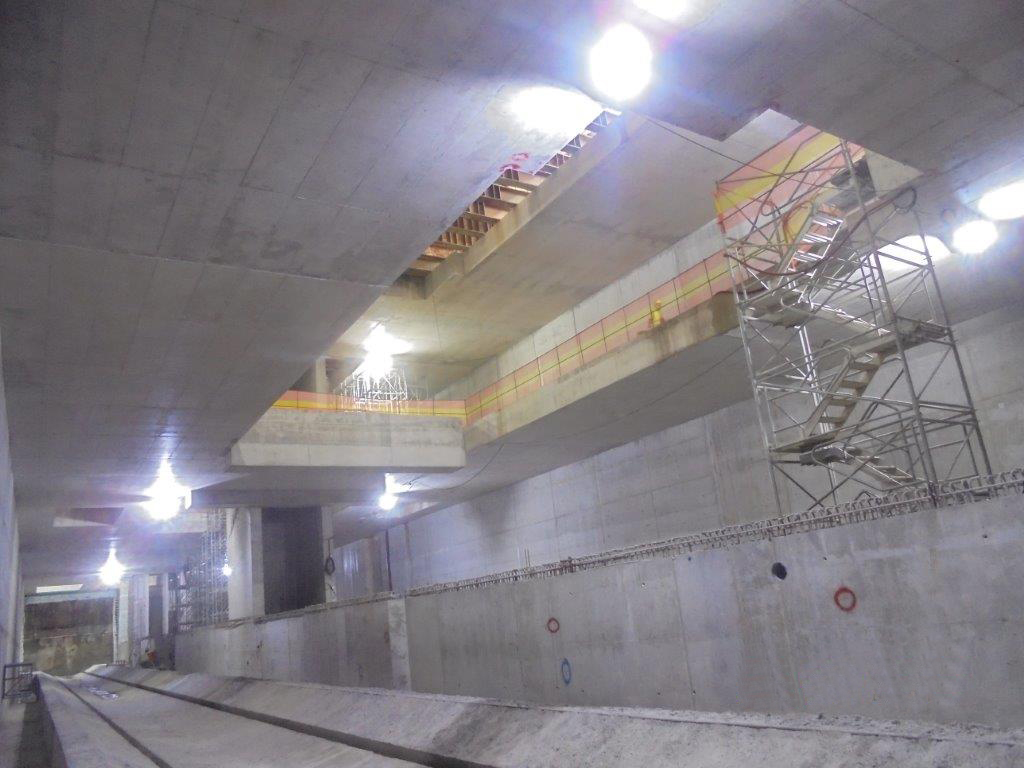

February 2018

• Kritis shaft: The works related to the excavation and temporary retaining of struts down to level -4 have been completed. The excavation and temporary retaining of struts down to level -5 are in progress. • NOMARCHIA Station: The removal of reinforced concrete struts (roof level), as well as the…
Μάθε Περισσότερα

January 2018

Nomarchia Station: The implementation of phase C’ of traffic arrangements and the construction of retaining piles at the north access (at a part of Vas. Olgas street) have been completed. Plastering works are in progress. • KALAMARIA Station: In progress is the construction of the permanent lining and waterproofing of…
Μάθε Περισσότερα

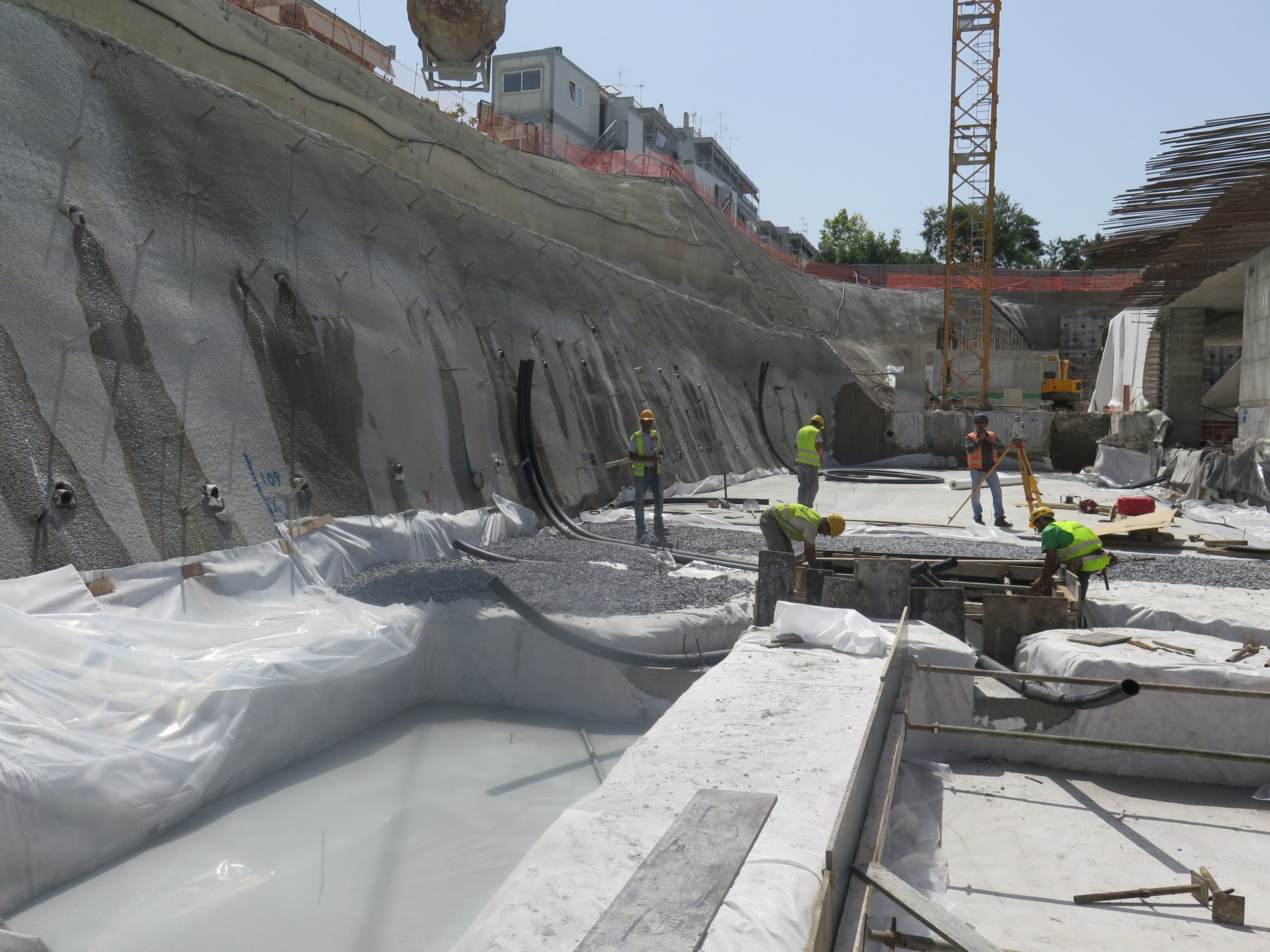

April 2017

NOMARCHIA Station: The permanent lining at level -1 has been completed. Works for the construction of the slab at level -2 are in progress. • KALAMARIA Station: The construction of the permanent lining at level -3 has been completed. The construction of the slab at level -2 is in progress.…
Μάθε Περισσότερα

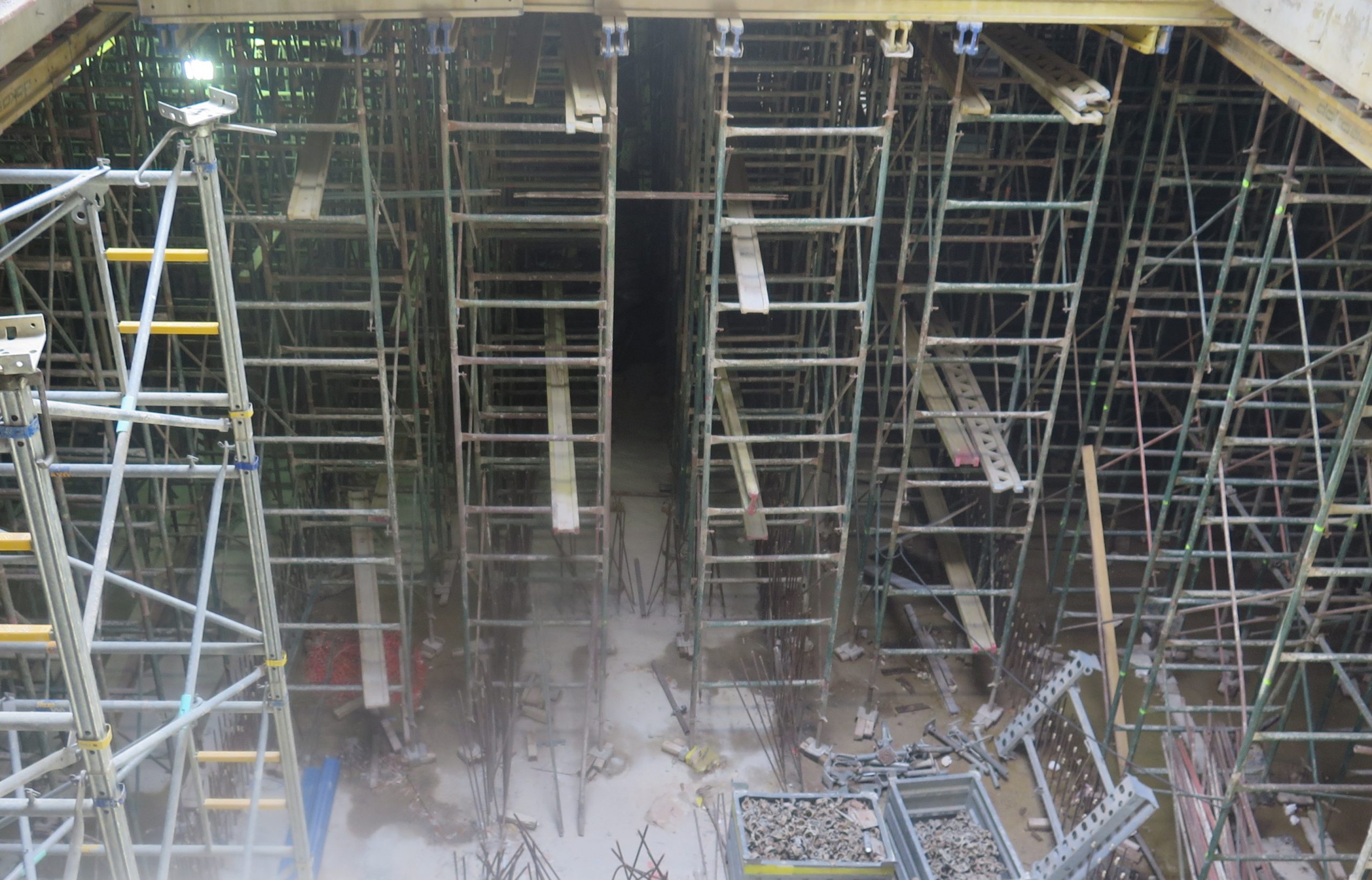

January 2017

• NOMARCHIA Station: The construction of the slab at level -2 has been completed, while in progress is the construction of the permanent lining from level -2 to level -1. • NOMARCHIA Crossover: In progress is the construction of the permanent lining from level -1 to the roof level. •…
Μάθε Περισσότερα

December 2016

NOMARCHIA Station: The construction of the permanent lining from the foundation slab up to level -2 has been completed, while the construction of the level -2 slab is in progress. NOMARCHIA Crossover: The construction of the permanent lining from the foundation slab up to level -1, as well as the…
Μάθε Περισσότερα

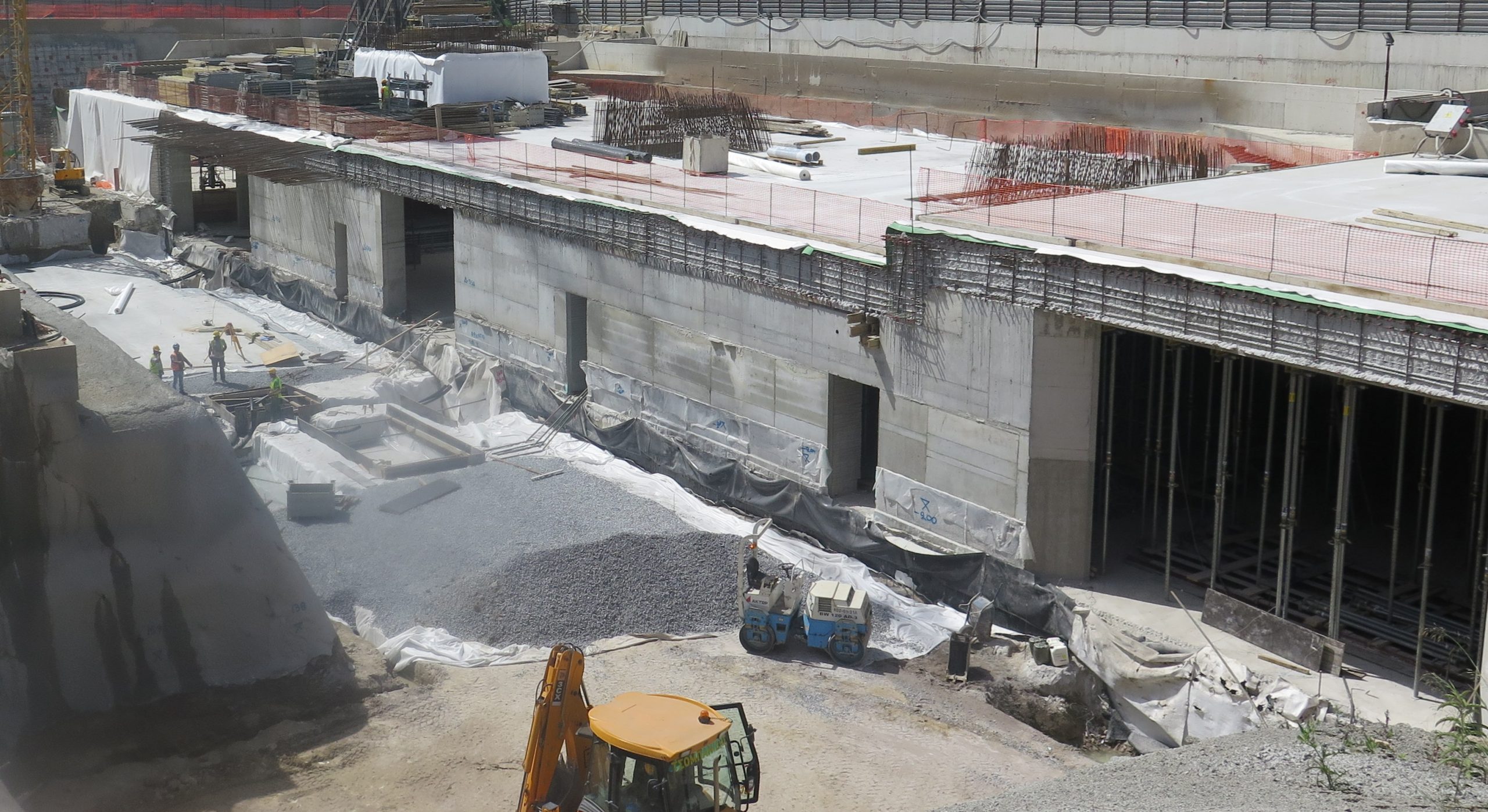

November 2016

NOMARCHIA Station: The construction of the permanent lining from the foundation slab up to level -2 is in progress. NOMARCHIA Crossover: The construction of the permanent lining from the foundation slab up to level -1 was completed. In progress is the construction of the slab of level -1 and the…
Μάθε Περισσότερα

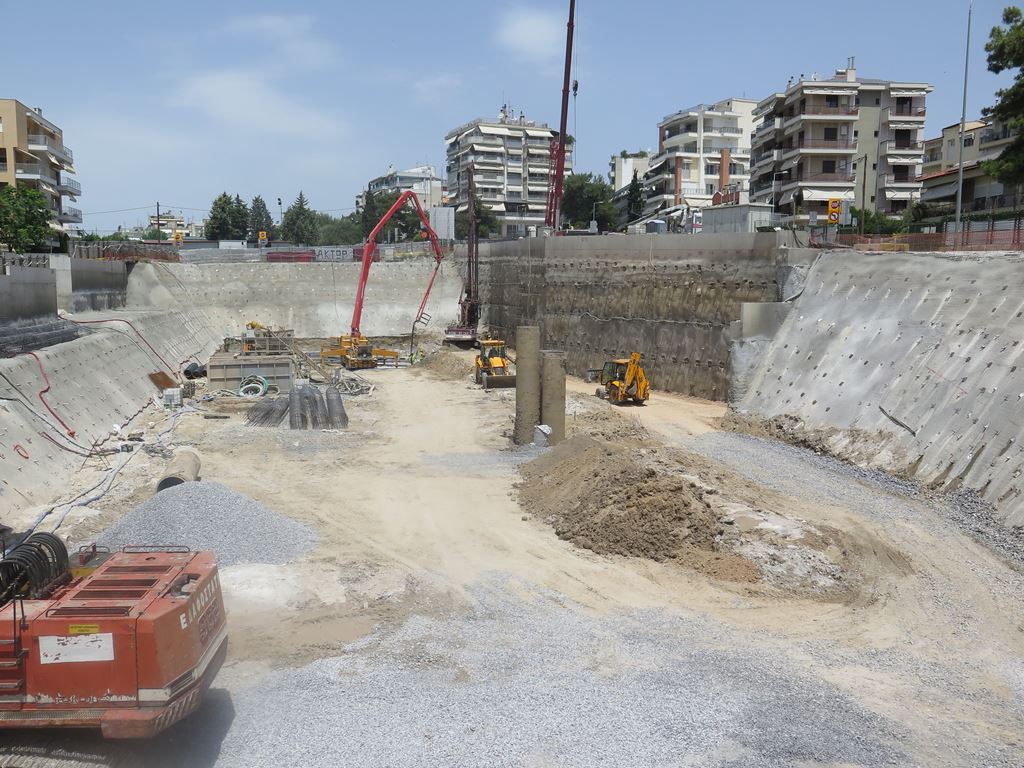

October 2016

NOMARCHIA Station: The waterproofing of masonry walls from the foundation slab to level -1 has been completed, while in progress is the construction of the platform. NOMARCHIA Crossover: The waterproofing of masonry walls from the foundation slab to level -1 has been completed. In progress is the construction of scaffolding…
Μάθε Περισσότερα

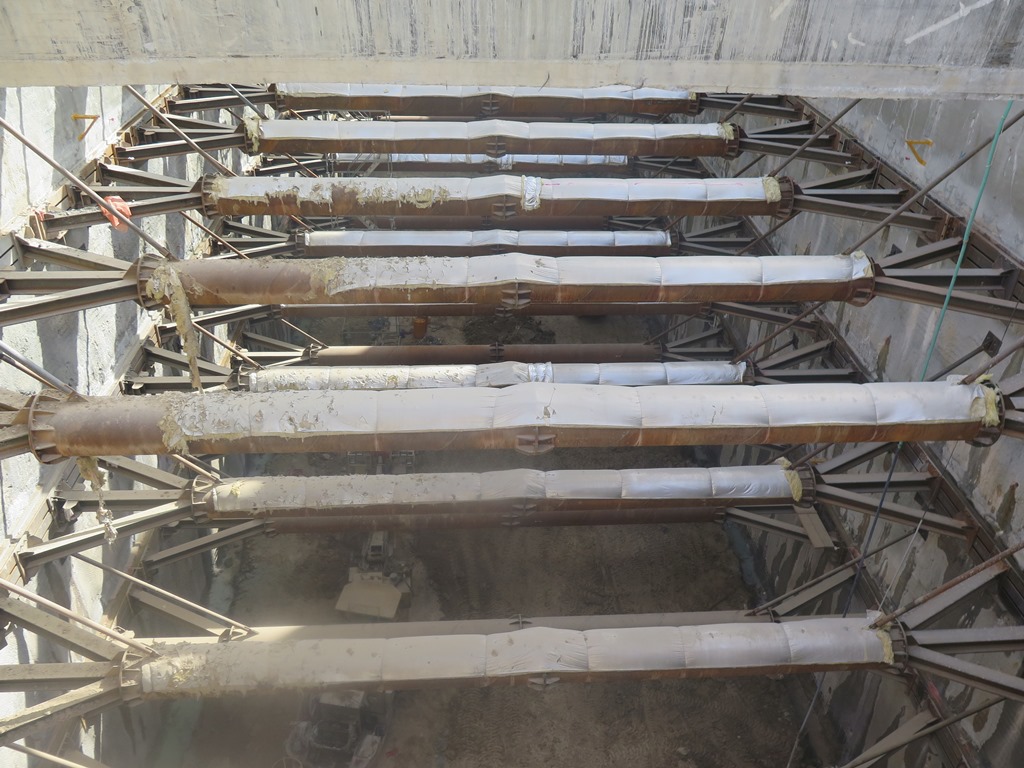

September 2016

NOMARCHIA Station: The works for the construction of the foundation slab have been completed. The construction of the permanent lining from the foundation slab up to level -1 is in progress. Nomarchia Junction: The construction of the foundation slab is completed. The removal of the struts at the last level…
Μάθε Περισσότερα

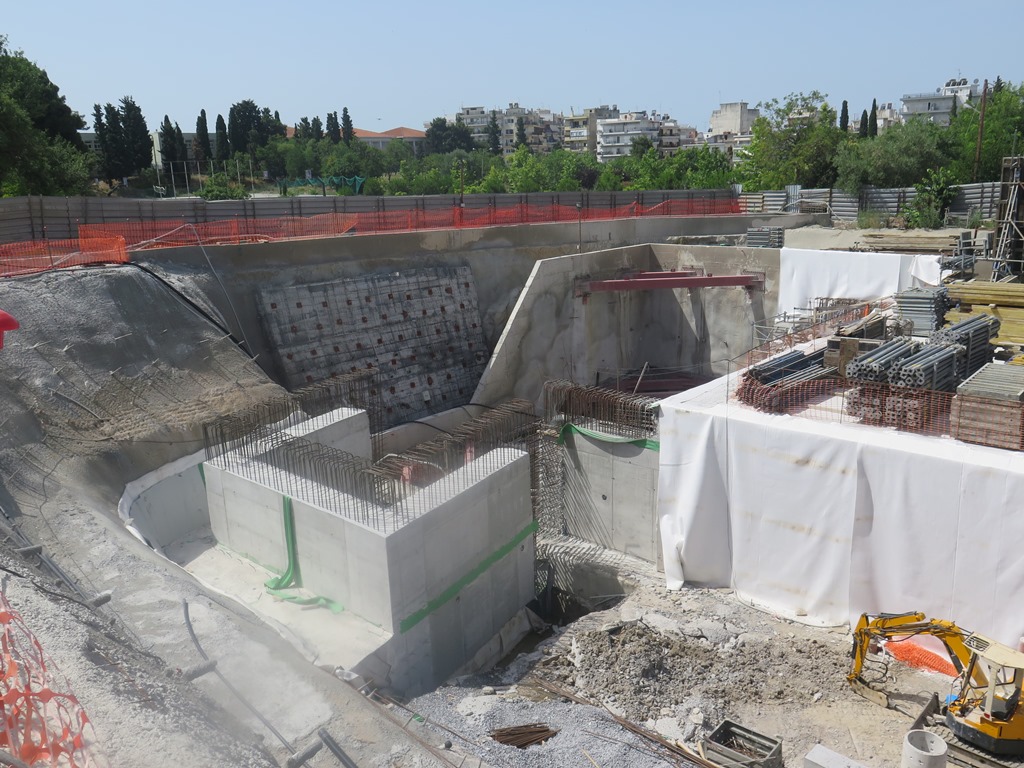

August 2016

NOMARCHIA Station: The works for the construction of the foundation slab are in progress. KALAMARIA Station: The works for the temporary retaining of the metal struts up to the 4th level are in progress. ARETSOU Station: The installation of metal struts at the 2nd level has been completed. In progress…
Μάθε Περισσότερα
