Kalamaria Project progress

January 2016

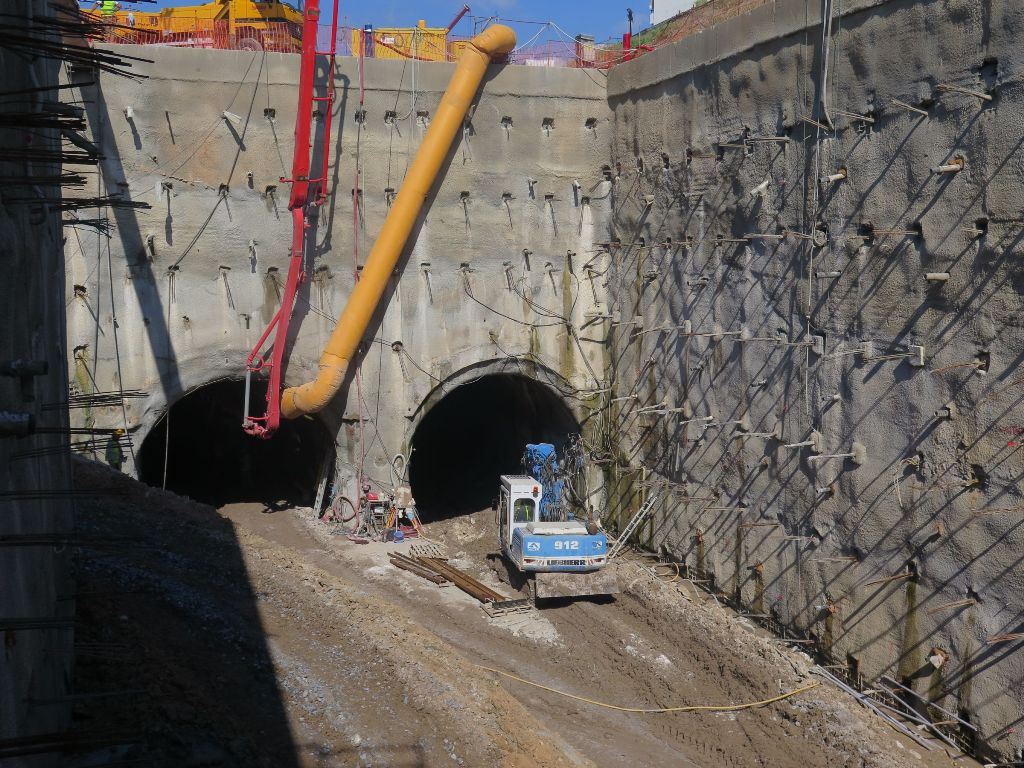

NOMARCHIA Station: The excavation of the station’s level -1 is completed, while the works for the installation of metal struts at level -1 are in progress. NOMARCHIA Crossover: The excavation of the crossover’s level -1 is completed, while the works for the installation of metal struts at level -1 are…
Μάθε Περισσότερα

December 2015

NOMARCHIA Station: The construction of struts made of reinforced concrete has been completed, while the excavation of the station’s level -1 is in progress; NOMARCHIA Crossover: The construction of struts made of reinforced concrete has been completed, while the excavation of the crossover’s level -1 is in progress; KALAMARIA Station:…
Μάθε Περισσότερα

November 2015

NOMARCHIA Station: Works for the perimeter piles and piles cap beam have been completed, while the construction of struts made of reinforced concrete at level -1 are in progress. NOMARCHIA Crossover: Works for the construction of perimeter retaining piles and their cap beam have been completed. The works for the…
Μάθε Περισσότερα

October 2015

NOMARCHIA Station: Works for the phase A excavation, the construction of struts at level -1 and the perimeter piles cap beam are in progress; NOMARCHIA Crossover: Works for the construction of perimeter retaining piles and their cap beam, as well as works for the diversion of PUO networks are in…
Μάθε Περισσότερα

September 2015

NOMARCHIA Station: Works for the excavation of station level -1 and works for the diversion of PUO networks are in progress; NOMARCHIA Crossover: Works for the construction of perimeter retaining piles and works for the diversion of PUO networks are in progress; KALAMARIA Station: Works related to the implementation of…
Μάθε Περισσότερα

August 2015

NOMARCHIA Station: The works for the construction of retaining piles at the perimeter of the station were completed. The works for the construction of a pile cap beam are in progress; KALAMARIA Station: Works for the construction of piles at the western part of the station are in progress; NEA…
Μάθε Περισσότερα

July 2015

NOMARCHIA Station and Crossover: The works for the diversion of PUO networks are in progress. The works for the construction of piles are at an advanced stage; KALAMARIA Station: Works for the construction of temporary retaining piles are in progress; ARETSOU Station: Investigation trenches are in progress; NEA KRINI Station:…
Μάθε Περισσότερα

June 2015

NOMARCHIA Station and Crossover: The works for the construction of temporary retaining piles are at an advanced stage; KALAMARIA Station: Works for the construction of temporary retaining piles are in progress; NEA KRINI Station: Works for the retaining of the station are in progress (installation of struts at the 2nd…
Μάθε Περισσότερα

May 2015

NOMARCHIA Station and Crossover: Construction works for the implementation of the traffic arrangements – Phase A have commenced, while works for the diversion of PUO networks are at an advanced stage. Piling works for the temporary retaining are in progress. The assembly of the building crane has been completed; KALAMARIA…
Μάθε Περισσότερα

April 2015

NOMARCHIA Station and Crossover: Piling works for the temporary retaining and the foundation of the building crane have commenced. Works for the occupation of the worksite are in progress, while works for the diversion of PUO networks are at an advanced stage; KALAMARIA Station: Works for the occupation of the…
Μάθε Περισσότερα
