Year: 2021

March 2021

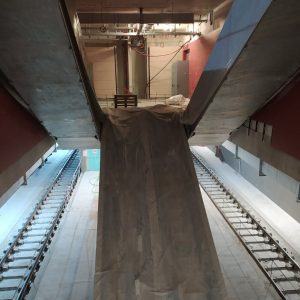

  NOMARCHIA Station (Station and Crossover): Works for the installation of manhole covers, reinstatement related works at street level and works for the installation of HVAC system equipment are in progress. KALAMARIA Station: In progress are works for the installation of a metal structure to support the glass panels of…
Μάθε Περισσότερα

March 2021

    New Railway Station: Works for the installation of cable trays at the signaling and telecommunications technical rooms have been completed. Works for the installation of equipment of the fire fighting system in tunnels are in progress. DIMOKRATIAS STATION: Works related to the installation of the air ducts network…
Μάθε Περισσότερα

FEBRUARY 2021

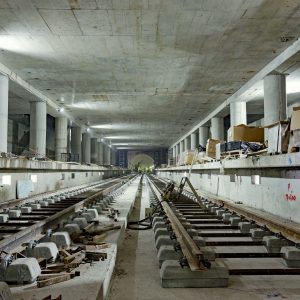

TZAVELA SHAFT The following works have been completed: Completion of the permanent lining of the shaft and of the connecting tunnel. The following works are in progress: Masonry walls. MANIATIKA STATION STATION’s OPEN CUT The following works have been completed: Completion of the permanent lining of the shaft. The following…
Μάθε Περισσότερα

February 2021

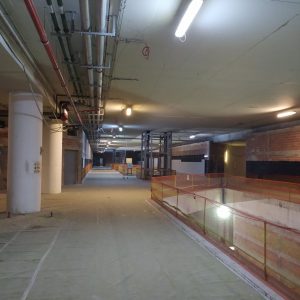

  NOMARCHIA Station (Station and Crossover): Remaining floor paving works, as well as works for the installation of galvanized balustrades are in progress. KALAMARIA Station: In progress are reinstatement works at street level and works for the installation of glass panels at the sheds of the eastern and western entrance.…
Μάθε Περισσότερα

February 2021

  New Railway Station: Works for the installation of cable trays at the signaling and telecommunications technical rooms are in progress. DIMOKRATIAS STATION: Works related to the installation of the air duct networks at level -1 are in progress. VENIZELOU Station: Archaeological excavations are in progress at the southern entrance.…
Μάθε Περισσότερα
JANUARY 2021

JANUARY 2021

  MANIATIKA STATION STATION’s OPEN CUT The following works have been completed: Completion of the permanent lining of the shaft The following works are in progress: Waterproofing of the roof slab Masonry walls – plastering works at levels -4, -3, -2 and -1 Architectural finishes – Painting works at level…
Μάθε Περισσότερα
ΚΑΛΑΜΑΡΙΑ - ΙΑΝΟΥΑΡΙΟΣ 2021

January 2021

  NOMARCHIA Station (Station and Crossover): Reinstatement related works at street level, as well as works for the installation of galvanized balustrades are in progress. KALAMARIA Station: In progress are works for the installation of glass panels of the sheds at the west entrance, as well as works for the…
Μάθε Περισσότερα
ΒΑΣΙΚΟ ΕΡΓΟ - ΙΑΝΟΥΑΡΙΟΣ 2021

January 2021

    DIMOKRATIAS STATION: Works related to the installation of fire fighting, sewage and water supply networks at level -2 have been executed. AGHIA SOFIA Station: Preparatory works for the construction of masonry at levels -2 and -3 are in progress. SINTRIVANI Station: The works for the installation of sub-frames…
Μάθε Περισσότερα
