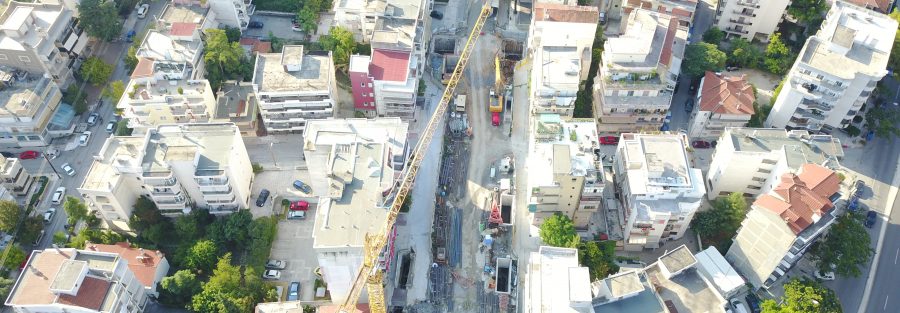

NEW RAILWAY Station: the configuration of the surrounding area is in progress.

• DIMOKRATIAS Station: The installation of metal doors at levels -1 and -2 of the station and the backfilling of the south access of the station are completed. The construction of the station’s walls and the implementation of traffic regulation – phase K’ at the intersection are in progress.

• VENIZELOU Station: The dismantling of diaphragm walls in the areas of the north and south access is in progress.

• SINTRIVANI Station – EXPO: Completed are the construction of the south access, the construction of terminations and parapet walls at the south access and the configuration of the surrounding area at the south access. In progress is the implementation of traffic arrangement – phase E’.

• PAPAFI Station: The following works are in progress: painting of the shafts, wall cladding with ceramic tiles, construction of gypsum boards and E/M installations (cable trays, earthing, sewage, fire fighting, fire detection, HVAC air ducts).

• EFKLIDIS Station: Floor lining with granite tiles at level -1 has been completed. In progress are the configuration of the surrounding area, the installation of balustrades at the emergency exit staircases and the wall cladding with granite slabs.

• FLEMING Station: Painting works are completed, while is progress is the installation of metal doors, the installation of outdoor grating at the ventilation shafts, as well as the E/M installations (sewage, fire fighting, fire detection, LV cables, lighting, blast shafts equipment).

• ANALIPSI Station & Crossover: In progress are works for the construction of industrial floors, wall plastering and painting works at the crossover and the Station shafts.

• 25 MARTIOU Station & Crossover: The construction of the east access has been completed, while painting works and works for the installation of metal doors are in progress.

• NEA ELVETIA Station and Crossover: The construction of the south access of the station, as well as of the PPC manhole has been completed. In progress are waterproofing works at the south access and in the PPC manhole, works for the installation of metal doors in the station, painting works at the crossover and E/M works (water supply, sewage).

• Depot – Building Complex I: The following works are in progress: construction of skylights on the roof of the metal structure, installation of window frames and the construction of gypsum board lining in sanitary areas, the offices and building No. 7. Building Complex II: The following works are in progress: construction of gypsum boards in OCC and in building No. 9, the construction of roof at section IV, the construction of side coverings at the north façade of the OCC and the installation of rails.

• Cut & Cover (C&C) and NATM Tunnels: (EYATH) pipes currently returned to their original location at sections II and III, while the reinstatement of sidewalks on Allatini street is in progress.
