Web Portal - Elliniko Metro A.E.
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa

February 2020

NEW RAILWAY Station: In progress are the works related to the lift installation and the construction of filling concrete and sidewalk base.

PAPAFI Station: The works for the installation of Platform Screen Doors (PSD) have been completed. In progress are earthing construction works.

FLEMING Station: In progress are the works for the installation of fire-rated platform air ducts, as well as the works for the installation of Platform Screen Doors (PSD).

ANALIPSI Station (Station and Crossover): The works for the installation of PSD suspension rod are in progress.

25TH MARTIOU Station: In progress are the works for the installation of the tunnel fire fighting and water supply network, as well as the works for the installation of the access control and safety system.

VOULGARI Station: The configuration works at street level are in progress.

NEA ELVETIA Station: In progress are the works for the installation of cable trays, the construction of equipment earthing and the installation of the lighting system.

DEPOT:

Building Complex Ι: In progress are plastering works at the washing plant, as well as works for the installation of cable trays.

Building Complex ΙΙ: In progress are the works for the construction of gypsum boards, wooden sub-frames and painting works, as well as works for the construction of in-floor cable ducts, the installation of fire detection cables for the ventilation-A/C equipment and works for the installation of lifts.

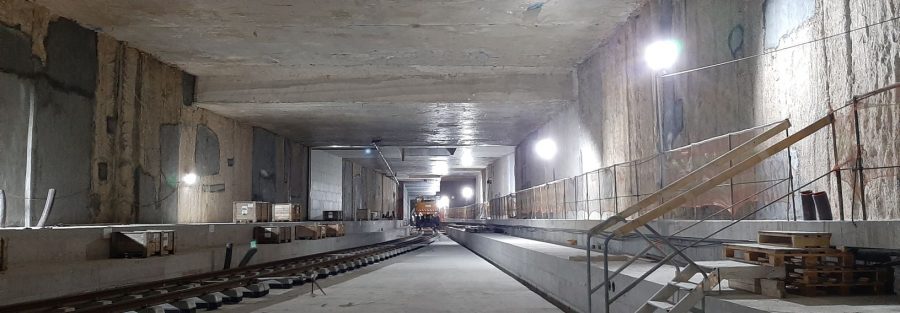

TBM tunnels: The construction of trackwork at a specific section of the Project tunnels is in progress.

WCAG
