Web Portal - Elliniko Metro A.E.
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa

December 2020

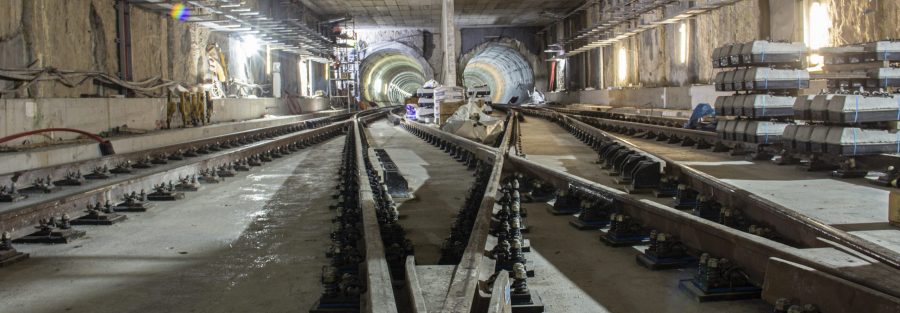

THESSALONIKI_12_20



  • NEW RAILWAY STATION: Works related to the construction of masonry walls and plastering related works have been executed.
  • VENIZELOU Station: The works for the removal of the equipment and installations at the south access have been completed.
  • AGHIA SOFIA Station: Works for the construction of parapet walls’ terminations at the south access, as well as roof waterproofing related works have been completed.
  • SINTRIVANI Station: The construction of the platform filling concrete has been completed and the works for the installation of sub-frames to support the platform air duct inlets are in progress.
  • PANEPISTIMIO Station: The works for the construction of the platform filling concrete are in progress.
  • FLEMING Station: In progress are works for the installation of ventilation – A/C equipment.
  • ANALIPSI Station: The works for the installation of fire-rated air ducts (OTE/SAF), at track 2 level, are in progress, while the works for the installation of traction power supply related equipment and cabling have been completed.
  • VOULGARI Station: In progress are works for the installation of the automatic fire extinguishing network in the area accomodating traction power equipment.

DEPOT

Building Complex Ι: In progress are works for the installation of the lighting system.

Building Complex ΙΙ: In progress are painting works, works for the construction of elevated floors, the installation of cable trays, the installation of A/C system, as well as works for the installation of telecommunications system.

TRACKWORK:

In progress are the works for the construction of the floating slabs between ANALIPSI and 25 MARTIOU Stations, as well as the works for the construction of the floating slabs/turnovers at 25 MARTIOU crossover. Moreover, in progress are works for the installation of the 3rd rail, the installation of cable trays, as well as alignment works and works for the installation of signalling equipment between PANEPISTIMIO and VOULGARI Stations.



WCAG
