Θεσσαλονίκη Μάιος 2022

• New Railway Station: In progress are works for the installation of Platform Screen Doors (PSD) at tracks 1 & 2 and works for the installation of guides for aluminum panel lining at the ticketing level.
• DIMOKRATIAS Station: Completed are the works for the installation of PSDs, while reinstatement works at street level on 26 Octovriou Street are at the completion stage. In progress are works for the installation of guides for aluminum panel lining at the ticketing level, as well as works for the construction of false ceiling made of gypsum boards in the area of the northern access.
• VENIZELOU Station: The works for the temporary detachment of antiquities along with an archaeological excavation survey continue. The archaeological excavation is also in progress at the north and at the south accesses of the station. At the east part of the station (level -1), completed is the dismantling of the central piles and the works for the installation of struts are at the completion stage.
• AGHIA SOPHIA Station: Completed are works for the installation of floor screed at the emergency exits. In progress are works for the installation of the perimeter angle to support the elevated floors in the technical rooms, the works for the installation of air exhaust (OTE) and air intake (SAF) ducts at track level 2, as well as works for the installation of escalators at the north access.
• SINTRIVANI Station: In progress are dry construction works in ventilation areas at levels -2 and -3, as well as works for the installation of elevated floors and the construction of fire stops.
• PAPAFI Station: Completed are works for the installation of galvanized handrails and the works for the installation of metal lining of the air ducts above of the PSDs. In progress are works for the installation of elevated floors in the technical equipment rooms for PSDs and UPS, works for the installation of the central fire detection switchboard in the fire fighting technical room, as well as preparatory works for the execution of stand-alone tests of the station’s MV switchboard.
• EFKLIDIS Station: Completed are works for the installation of the sub-frame for the suspension of the non-perforated metal panels for the cladding of the platform headwalls. In progress are works for the construction of the shed at entrance 1, as well as works for the installation of metal bases for the foundation of the lighting switchboards in LAS.
• FLEMING Station: Completed are platform cladding works with granite slabs and works for the installation of a frame for the suspension of the false ceiling using cement boards at the central access. In progress are works for the completion of the installation of the ventilation / A/C system.
• ANALIPSI Station: Completed are platform cladding works using granite slabs, while in progress are wall cladding works using aluminum panels, as well as works for the installation of elevated floors in the technical rooms.
• 25 MARTIOU Station: Traffic arrangement D was implemented, while in progress are vertical marble cladding works at the east access as well as works for the installation of false ceiling suspension frames in the public areas.
• NEA ELVETIA Station: Completed are marble cladding works at entrance 2 and in progress are marble cladding works at entrance 1, works for the installation of false ceilings at the ticketing level, works for the installation of an elevated floor at the LAS, as well as works for the installation of pumping station equipment.

DEPOT:

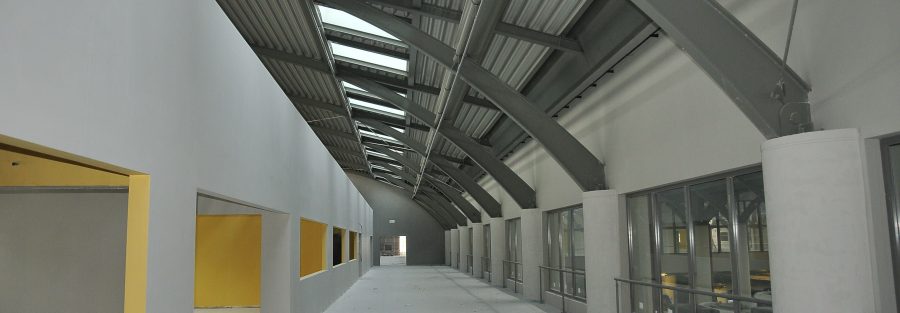

Building Complex I: Completed are floor lining works in office areas using linoleum at levels +1, +2 and +3, works for the installation of false ceilings in office areas, corridors and sanitary areas at all levels, works for the construction of the shed roof at the south view of the workshop, as well as works for the installation of the interior glass panel of the canteen. In progress are works for the installation of false floors at the staircases, painting works at levels +1, +2 and at the staircases, works for the installation of glass panes at the central entrance and flooring works in parking areas at levels -2 and -1. With regard to the electromechanical installations, completed are tests of the compressed air supply network, as well as low voltage equipment cabling works at the washing plant. In progress are works for the construction of the network and the gas detection system.

Building Complex II: With regard to the Administration Building and the Operation Control Centre, completed are works for the installation of acoustic panels at the terrace as well as waterproofing works at the planted terraces. In progress are painting works at level +1. At building 2, completed are marble cladding works at the staircases of section V, while in progress are lining installation works using gypsum boards at level 0, works for the construction of partitions and lining using gypsum boards at levels -1/0, works for the installation of the glass panel at the south view, as well as painting works at level 0.

TRACKWORK: Completed are works for the construction of the floating slab at track 2 at the inter-station between NEW RAILWAY Station and DIMOKRATIAS Station. In progress is the construction of the crossover at the NEW RAILWAY Station. In addition, in progress are works for the installation of the 3rd rail between DIMOKRATIAS and the NEW RAILWAY Stations.
