Web Portal - Elliniko Metro A.E.
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa
Θεσσαλονίκη Ιούλιος 2023
  • NEW RAILWAY Station: Completed are the works for concreting the temporary opening slab in the forestation area intended for the arrival of equipment, the installation of perforated soundproof panels at track level 2, the application of sound proof coating in the east pumping station, the installation of granite plugs and skirting around the openings of the slabs at the transfer level, and works for the installation of the bus-duct connecting the transformers with the low voltage systems general switchboard. In progress are the works for the construction of the western shaft and the fire stops.
  • DIMOKRATIAS Station: Completed are works for the installation of false ceiling supports at level -2, the installation of fans of the tunnel ventilation system, as well as the installation of the bus duct connecting the transformers with the low voltage general switchboard in the LAS. In progress are works for the construction of vertical cladding using aluminum panels in public areas, the construction of fire stops, earthing, the installation of the fire-detection system, the installation of air-ducts and equipment of the ventilation / air-conditioning system, as well as the works for the installation of for the access control and intrusion detection system.
  • VENIZELOU Station: Completed are works for the construction of masonry wall and the application of plastering at the ticketing level, as well as painting works of the ceiling of track 2, of the western emergency exit stairways and the perimeter walls from the foundation slab up to the electromechanical areas level. In addition, completed are the works for the installation of the metal sub-frame over the PSDs at tracks 1 and 2, the works for the construction of the sound-proofing panels at the platform level, the works for the installation of the indoor escalators of the station, as well as the works for the installation of the perimeter steel-angles for supporting the elevated floors in the technical areas at level -3 and in the Station Master Room. . Moreover, completed are the works for the undisturbed cut in the area of the south-east ventilation shaft for its connection with the main station, the works for the construction of the northern access foundation slab and the perimeter walls from level -2 to level -1, as well as the construction of lab at level -1 at the southern access. In addition, completed are the works for the dismantling of the struts in the southern access area, as well as the installation of the air-ducts of the tunnel ventilation system at the roof of tracks 1 and 2. In progress are the works for the installation of the PSDs at track 1 side, the installation of the air-ducts of the tunnel ventilation system at the roof of track 2, the installation of air-ducts and equipment of the ventilation / air-conditioning system in the technical rooms at level -3, as well as the works for the installation of electrical cables and trays at the electromechanical areas level. Moreover, in progress are the works for the installation of trays’ supports at the ticketing level, the works for the installation and connection of the telecommunications and signaling systems’ switchboards, the works for the construction of water supply, sewage and firefighting networks, as well as the works for the installation of the permanent lining of the northern access and the construction of the station’s southern access. In addition, in progress are the works for placing back and preservation of the archaeological finds / unities at level -1.
  • AGIA SOFIAS Station: Completed are the works for the installation of elevated floors in the technical rooms, works for the installation of stainless steel balustrades in public areas, the works for the construction of the infrastructure and the final transportation of the traffic signaling pillars, as well as the works for the construction of the fair-faced shotcrete in the area where the antiquities are preserved in the northern access. In progress are the works for floor lining using granite slabs at the platform level and at levels -1 and -2, the works for the construction of vertical marble cladding at all levels, the works for surface reinstatement at street level at the northern access and at Agias Sofias Street, the works for the installation of trays at platform level, the installation of earthing, as well as the installation of cables.
  • SINTRIVANI Station: Completed are the final painting works, as well as the planting activities in the “Asylo tou Paidiou” Institute, while in progress are electrical connection works and testing in all installed electromechanical systems.
  • PANEPISTIMIO Station: In progress are works for the installation of aluminum panels in public areas, the installation of steel panel lining at the indoor escalators, as well as testing of all installed electromechanical systems.
  • PAPAFI Station: Completed are the painting works in ventilation shafts, the installation of Station signs, as well as the installation of islands of automatic ticketing system gates. In progress are the works for the installation of the glass panes at the station sheds, the earthing related activities, as well as testing of all installed electromechanical systems.
  • EFKLIDIS Station: Completed are the works for the removal of the worksite offices, the electrical connection of the pumping station switchboard, as well as the installation of islands of automatic ticketing system gates. In progress are the works for the installation of lighting fixtures at the platform level, as well as testing of all installed electromechanical systems.
  • FLEMING Station: Completed are works for the installation of steel panels at the bottom side of the escalators, the installation of glass panes of the outdoor lift, the reinstatement works at street-level, as well as the installation of islands of automatic ticketing system gates. In progress are the works for completing the access control and intrusion detection system, as well as testing of all installed electromechanical systems.
  • ANALIPSI Station: Completed are works for the installation of vertical cladding using steel sheets, while in progress are works for the installation of inlets of the ventilation / air-conditioning system, earthing works, preparatory works for the construction of the shed, as well as the testing of the installed electromechanical systems.
  • 25 MARTIOU Station: Completed are works for the connection of rain and foul water networks at street level, as well as the installation of islands of automatic ticketing system gates. In progress are works for the construction of fire-stops, the installation of lighting fixtures in public areas, as well as the testing of the installed electromechanical systems.
  • VOULGARI Station: Completed are vertical cladding works using aluminum panels at the station accesses, while in progress are the works for the installation of the building automatic control system’s cabling, as well as the testing of the installed electromechanical systems.
  • NEA ELVETIA Station: Completed are the vertical cladding works using aluminum panels, the installation of the glass panes in the lift, as well as the installation of fire-stops. In progress are works for the installation of the power distribution cables, the connection of cables of the jet fans situated into the tunnel between the station and the depot, as well as the testing of the electromechanical systems installed.

DEPOT

  • Building Complex Ι: With regard to electromechanical installations, completed are the works for the installation of FHCs, the installation and connection of gas panels, as well as the roller shutters’ connection activities. In progress are the works for the installation of the equipment of the access control and intrusion detection system, the installation of cable trays, as well as the works for the connection of the ventilation / air conditioning systems’ fans at the terrace.
  • Building Complex ΙΙ: With regard to the Administration Building and the Control Centre, completed are the works for the installation of the metal doors, while in progress are works for the installation of stainless steel lining on the walls of the lifts at all levels, as well as slab paving works at the central yard. In Building 2, in progress are lining works and the construction of partitions made of gypsum board in the kindergarten and the central guard house, works for industrial flooring in the kindergarten, the works for the installation of outdoor aluminum louvers and works for the installation of balustrades in the outdoor staircases. . With regard to the electromechanical works, completed are the works for the construction of the pipe and vane network, the execution of insulation works of fan coil units, the works for the installation of lighting switchboards, as well as the works for the construction of water supply and sewage networks. In progress are the works for the construction of the rain water piping network, the installation of the water supply and sewage networks in Building 4, the electrical connections in the LAS, the installation of the power distribution systems, the installation of the fire-detection systems, as well as the works for the installation of cable trays.

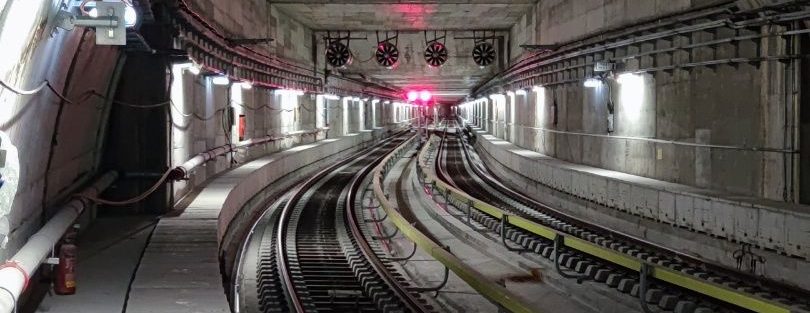

  • TRACKWORK: Completed are works for the construction of the trackwork and works for the installation of third rail in the entire project.
  • In progress are testing and commissioning works.
WCAG
