November 2016

  • NEOS SIDIRODROMIKOS STATHMOS Station: In progress are masonry works at level -1.
  • Dimokratias Crossover: Works for the construction of the northern part foundation micro-piles have been completed, while works for the construction of the foundation slab are in progress at the northern part.
  • DIMOKRATIAS Station: In progress is the archaeological excavation at the northern access and at the northwest shaft.
  • SINTRIVANI Station – Thessaloniki International Fair: Piling works have been completed at the southern access. In progress is the construction of the northern access, as well as the northern shaft walls and the archaeological excavation at the southern access.
  • SINTRIVANI Crossover: In progress are works for the closing of provisional openings of the slabs.
  • PANEPISTIMIO Station: Civil works have been completed.
  • PAPAFI Station: The construction of walls at level -2 and the slab of level -1 have been completed. In progress is the construction of walls at level -1, and the works at the northern ventilation shaft, as well as the works for the construction of the northern access.
  • FLEMING Station: Preliminary works for the next traffic phase.
  • ANALIPSI Station and Crossover: The works for the closing of openings at the slabs at the northern access were completed.
  • PATRIKIOU Station and Crossover: The construction of the roof slab at the Crossover, as well as the retaining piles at the eastern ventilation shaft and the excavation at level -1.
  • VOULGARI Station: The construction of the roof slab has been completed. Excavation works at level -1 are in progress.
  • NEA ELVETIA Station and Crossover: Excavation and temporary retaining works (construction of 5th -6th series of anchors) are in progress at a minor section of the station. Waterproofing works at a section of the foundation slab are also in progress.

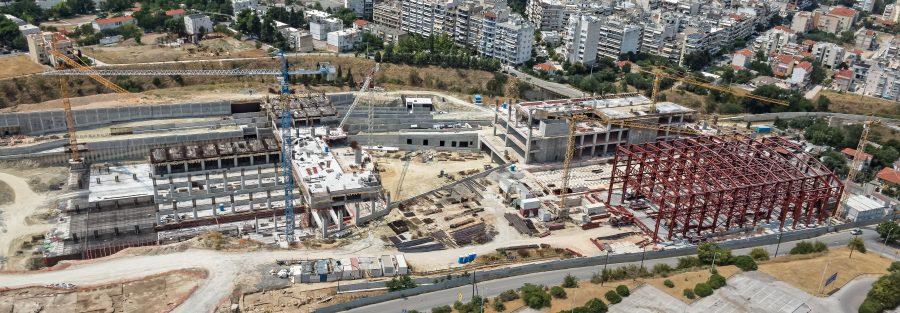

  • DEPOT: Building complex I: The reinforced concrete bearing structure has been completed. Masonry works are being constructed at level +1. Building complex II: The construction of retaining walls in the surrounding area is in progress.
  • TBM Tunnels: Works for the boring of TBM2 tunnel at the section extending from Voulgari Station up to Patrikiou Crossover have been completed. Works for the boring of TBM1 tunnel extending from Voulgari Station up to Patrikiou Crossover are in progress, while in progress is also the jet grouting construction process in Patrikiou – Analipsi interstation.
  • Cut and Cover Tunnel – Section I: In progress are waterproofing works in a section of the tunnel invert. Section III: Excavation and temporary retaining works of the NATM tunnel are in progress.
