Web Portal - Elliniko Metro A.E.
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa
ELLINIKO METRO A.EELLINIKO METRO A.EELLINIKO METRO A.E logo espa

December 2016

  • NOMARCHIA Station: The construction of the permanent lining from the foundation slab up to level -2 has been completed, while the construction of the level -2 slab is in progress.
  • NOMARCHIA Crossover: The construction of the permanent lining from the foundation slab up to level -1, as well as the construction of the slab of level -1 were completed. In progress is the construction of the permanent lining from level -1 to the roof level.

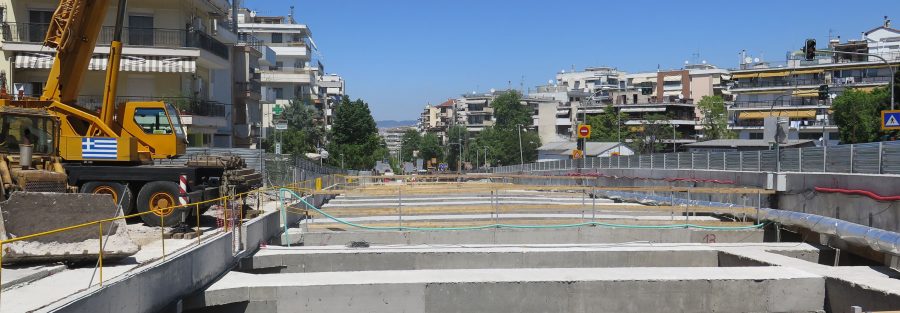

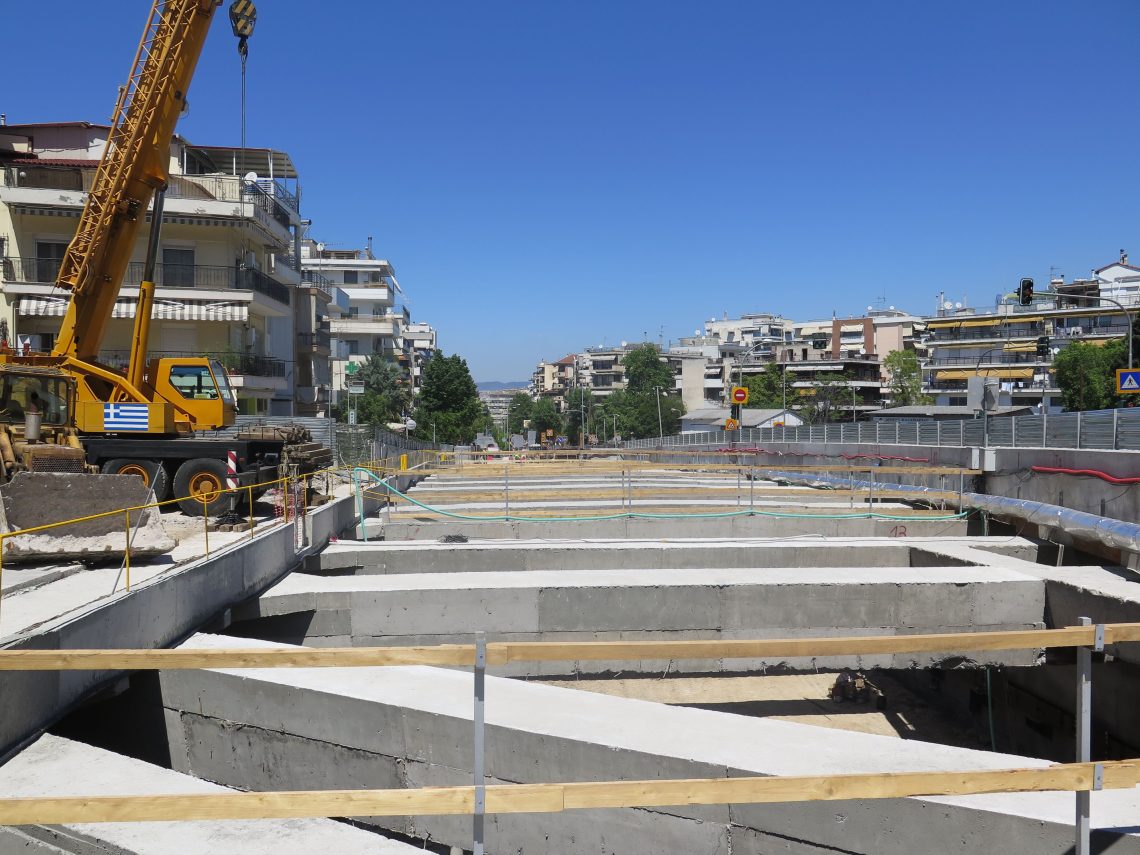

  • KALAMARIA Station: The excavation and temporary retaining works have been completed, while in progress is the waterproofing of the final level and the perimeter walls, as well as the construction of the pumping station.
  • ARETSOU Station: The construction of the foundation slab has been completed, while in progress is the construction of the permanent lining from the invert slab to level -2.
  • MIKRA Station 1st Crossover and Station part: The construction of the foundation slab has been completed and the construction of perimeter walls is in progress.
  • MIKRA Station 2nd Crossover and Station part: The excavation up to the final level has been completed, while in progress is the waterproofing of the final level and the perimeter walls.
  • MIKRA Forestation – Sections 1-2: The excavation of the 4th level is in progress. Sections 4 – 5: Excavation completed. Sections 7-8: The construction of the 2nd row anchors is in progress.
  • Terminal shaft: The installation of the 2nd level steel struts has been completed.
  • The preparation and approval of designs are in progress.
WCAG
